Nowra CBD Revitalisation Strategy Committee
Meeting Date: Tuesday, 04 April, 2023
Location: Jervis Bay Rooms, City Administrative Centre, Bridge Road, Nowra
Time: 4.00pm
Please note: Council’s Code of Meeting Practice permits the electronic recording and broadcast of the proceedings of meetings of the Council which are open to the public. Your attendance at this meeting is taken as consent to the possibility that your image and/or voice may be recorded and broadcast to the public.
Agenda
1. Apologies
2. Confirmation of Minutes
· Nowra CBD Revitalisation Strategy Committee - 27 February 2023.......................... 1
3. Declarations of Interest
4. Reports
CBD23.10... Committee Actions Report for Ongoing / Completed Items........................... 5
CBD23.11... Quarterly Report No.1 - Nowra Riverfront Precinct Project......................... 12
CBD23.12... Update report - Community Mural Proposal - Laneway (Shoalhaven Regional Gallery) - 12 Berry St, Nowra..................................................................................... 18
CBD23.13... Standing Report - Budget Update - March 2023......................................... 20
CBD23.14... Standing Report - Project Update - March 2023.......................................... 23
CBD23.15... Proposal - 16 Berry Street Nowra................................................................ 26
CBD23.5..... Discussion Item - Future Character of New Builds in Nowra CBD.............. 27
5. General Business
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page i |
Membership
Mr James Caldwell – Chairperson
Clr Serena Copley
Clr Matthew Norris
Clr Tonia Gray
Clr Patricia White (Alternate)
Ms Jo Gash
Mr Scott Baxter
Mr Brendan Goddard
Mr George Parker
Mr Wesley Hindmarch
Ms Catherine Shields
Ms Jessica Bromley
Mr Carlo Di Giulio
Mr Jason Cox
Non-voting members
All other Councillors
CEO
Director, City Services or delegate
Quorum – Seven (7) members
Note: Any non-voting Councillor in attendance at the Committee meetings may act as an alternate voting member in circumstances where achievement of a quorum is required.
Role of the Committee
For the purpose of this Terms of Reference, Councils annual Capital Works Budget which is defined as any Special Rate on the CBD (currently $500,000) plus any top up funding (such as grants or loans obtained by council or other council budgetary allocations) that Council provides to deliver a project initiated by Special Rate Funding.
Note: Any other Capital Works Funding in excess of $100,000 within the CBD will be discussed with the Committee prior to expenditure of funding.
Note: Tasks in relation to part 4 will not be undertaken by Councillors
1. Recommend to Council possible refinement of, and improvements to, the ‘Revitalising Nowra Action Plan (2021-2023)’ and the broader Nowra CBD Revitalisation Strategy as the committee considers appropriate.
2. Develop a list of projects (with estimated costings) for Council to consider/prioritise over a rolling three year time frame, that will assist in achieving the ten elements of the Nowra CBD Revitalisation Strategy. The list is to be presented to an Ordinary Meeting of Council in February each year, and thus adopted by the Council.
3. Make a formal submission to Council’s annual capital works budget as it relates to the Nowra CBD, in accordance with Council’s budgeting process.
4. Reallocate at its discretion, Nowra CBD Revitalisation Budget funds to operational projects, e.g. activation events.
5. Monitor the expenditure of the Nowra CBD Revitalisation Budget via a Subcommittee, in particular;
5.1 Approving design plans and specifications at the preliminary concept stage and prior to the detailed drafting and then at final approval stage.
5.2 In cases where the CEO (or delegate) determines that capital works funded by the Nowra CBD Revitalisation Budget will be tendered out, the Subcommittee will endorse the tender documentation before tenders are advertised.
5.3 The Chair and delegate may, at their discretion, participate on tender evaluation panels for capital expenditure funded by the Nowra CBD Revitalisation Budget.
5.4 The Chair is to endorse the payment of progress claims and endorse the approval of variations, for capital expenditure funded by the Nowra CBD Revitalisation Budget.
6. Act as a communication conduit between Council and the CBD stakeholders in respect to the ten elements within the Nowra CBD Revitalisation Strategy and approved Capital Works within the Nowra CBD with reasonable support from Council, at Council’s expense, as determined by the CEO.
7. Assist Council in advocating to the community the adopted list of projects that seek to deliver on the ten elements of the CBD Revitalisation Strategy.
8. Provide a report to Council (resolved at a Committee meeting) each quarter outlining the year to date expenditure on projects funded by the Nowra CBD Revitalisation Budget and present a report to an Ordinary Meeting of Council in August each year that explains the expenditure and any non-expenditure, for the previous financial year.
9. Consult with relevant stakeholders as needed.
Delegated Authority
1. To oversee the expenditure of the Nowra CBD Revitalisation Budget, as the Committee deems appropriate in accordance with objectives of the Nowra CBD Strategic Plan.
2. To promote the advantages of the CBD inside and outside the Local Government area, including making press releases and promoting the Nowra CBD Revitalisation Strategy and its projects.
3. Council will provide “in-kind” support to the committee in relation to
· Project Design and Documentation
· Facilitation of meetings
· Preparation of reports for the Committee consideration
Nowra Revitalisation Committee - Sub/Working Groups
Governance & Communications Sub Committee |
Finance & Works Sub Committee |
Events & Promotion |
Activation Projects |
|
James Caldwell (Chair) |
Yes |
Yes |
|
|
Clr |
|
|
|
|
Clr |
|
|
|
|
Clr |
|
|
|
|
Wesley Hindmarch |
|
|||
Scott Baxter |
|
|||
Brendan Goddard |
|
|||
George Parker |
|
|
|
|
Jo Gash |
|
|
|
|
Catherine Shields |
|
|
|
|
Carlo Di Giulio |
|
|
|
|
Jessica Bromley |
|
|
|
|
Jason Cox |
|
|
|
|
Gordon Clark |
|
|
|
|
Paul Keech |
|
|
|
|
SCC Rep |
|
|
|
|
Minutes of the Nowra CBD Revitalisation Strategy Committee
Meeting Date: Monday, 27 February 2023
Location: Email Meeting
The following members participated in the Email Meeting:
Mr James Caldwell - Chairperson
Clr Serena Copley
Clr Matthew Norris
Clr Patricia White
Ms Jo Gash
Mr Scott Baxter
Mr Brendan Goddard
Mr Jason Cox
Apologies / Leave of Absence |
Nil
Confirmation of the Minutes |
RESOLVED (By consent)
That the Minutes of the Nowra CBD Revitalisation Strategy Committee held on Tuesday 9 January 2023 be confirmed. CARRIED
|
Declarations of Interest |
Nil
Reports
CBD23.2 Committee Actions Report for Ongoing / Completed Items |
HPERM Ref: D23/10439 |
RESOLVED (By consent) That the: 1. Outstanding/Ongoing Action Report be received for information. 2. Following completed item in the Action List attached to the report be removed from the listing: a. Item CBD22..46 - Request Update - Riverfront Precinct Project – Quarterly CARRIED
|
CBD23.3 Standing Report - Project Update - January 2023 |
HPERM Ref: D23/21516 |
RESOLVED (By consent) That the Nowra CBD Revitalisation Strategy Committee note the update provided on the nominated projects within the Nowra CBD. CARRIED
|
CBD23.4 Standing Report - Budget Update - January 2023 |
HPERM Ref: D23/21518 |
RESOLVED (By consent) That the Nowra CBD Revitalisation Strategy Committee notes the following points for information: 1. That $21,760 has been spent since the last meeting of the Nowra CBD Revitalisation Strategy Committee budget update. 2. The total year-to-date spend for the 2022/2023 financial year is $390,445 of the available budget of $1,898,594. 3. A summary of expenditure is provided in the Attachment to this report. CARRIED
|
CBD23.6 Jelly Bean Park - Seats and Bicycle Racks |
HPERM Ref: D23/8328 |
Recommendation That Council investigate options to increase the number of seats and bicycle racks in Jelly Bean Park.
|
|
REcommendation (By consent) That Council investigate options to increase the number of seats and bicycle racks in Jelly Bean Park. CARRIED
|
CBD23.7 Taxi Rank - Junction Street - (near) Subway |
HPERM Ref: D23/8761 |
Recommendation That in relation to relocating the Nowra CBD Taxi rank locations: 1. The CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: a. Kinghorne Street near Coles/Aldi; and b. Near Telstra building, Stewart Place Bus Terminal. 2. The report include: a. Feasibility of the project b. Funding options for investigation and design c. Funding options for construction
|
|
REcommendation (By consent) That in relation to relocating the Nowra CBD Taxi rank locations: 1. The CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: a. Kinghorne Street near Coles/Aldi; and b. Near Telstra building, Stewart Place Bus Terminal. 2. The report include: a. Feasibility of the project b. Funding options for investigation and design c. Funding options for construction CARRIED
|
CBD23.8 Egans Lane Amenities |
HPERM Ref: D23/8788 |
Recommendation That in relation to the amenities at Jelly Bean Park (Egans Lane), the CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: 1. Feasibility of the project 2. Funding options for investigation and design 3. Funding options for construction
|
|
REcommendation (By consent) That in relation to the amenities at Jelly Bean Park (Egans Lane), the CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: 1. Feasibility of the project 2. Funding options for investigation and design 3. Funding options for construction CARRIED
|
CBD23.9 Electric Vehicle Parking Stations |
HPERM Ref: D23/8837 |
Recommendation That in relation to Electric Vehicle Charging Stations in the Nowra CBD, the CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: 1. Councils Policy position on Electric Vehicle charging stations and how it relates to the Nowra CBD 2. Options available to engage with Electric Vehicle charging station providers
|
|
REcommendation (By consent) That in relation to Electric Vehicle Charging Stations in the Nowra CBD, the CEO (Director City Services) investigate and report back to the Committee targeting the May 2023 meeting on the following: 1. Councils Policy position on Electric Vehicle charging stations and how it relates to the Nowra CBD 2. Options available to engage with Electric Vehicle charging station providers CARRIED
|
Mr James Caldwell
CHAIRPERSON
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.10 Committee Actions Report for Ongoing / Completed Items
HPERM Ref: D23/92384
Department: Business Assurance & Risk
Approver: Craig Exton, Manager - Technical Services
Attachments: 1. Action List ⇩
Reason for Report
To advise and update the Committee on the Outstanding/Ongoing Actions from the Nowra CBD Revitalisation Strategy Committee.
Recommendation (Item to be determined under delegated authority) That the Nowra CBD Revitalisation Strategy Committee receive the Outstanding/Ongoing Action Report for information. |
Options
1. As Recommended
2. Adopt an alternate recommendation
Background
The actions listed in the attachment are drawn from resolutions made by the Committee of which an action is required.

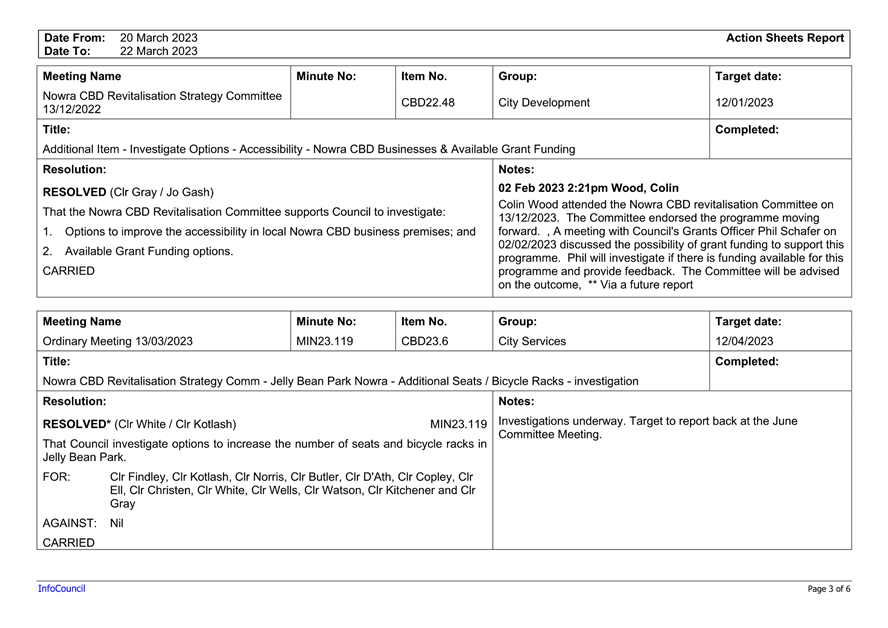

Outstanding/Ongoing Action Report (attached) is current as at the time of drafting this report (Wednesday 22 March 2023) and there are no completed actions from the previous report.
This will be a standing report on the agenda for each meeting to keep the Committee informed of progress on the actions / resolutions from previous meetings.
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.11 Quarterly Report No.1 - Nowra Riverfront Precinct Project
HPERM Ref: D23/69515
Department: Strategic Planning
Approver: Carey McIntyre, Director - City Futures
Reason for Report
To provide the Committee with an update on the Riverfront Precinct Project.
Options
1. Receive the report for information.
Implications: Ongoing quarterly update reports will be provided as work on the riverfront precinct continues.
2. Make an alternate recommendation.
Implications: Will depend on the nature of any recommendation, which could for example include providing feedback or requesting specific consideration of matters.
Background
This is the first quarterly update report arising from the resolution on 9 January 2023 that:
The Nowra CBD Revitalisation Strategy Committee request that the CEO provide quarterly updates on the progress of plans relating the development of the riverfront precinct.
Council staff will also attend the meeting to provide additional detail if needed.
The Precinct
The extent of the Nowra Riverfront Precinct (the precinct) is shown on the following aerial photograph and is bound by Scenic Drive to the north, Hawthorn Avenue to the east, Hyam Street and Graham Street to the south and Shoalhaven Street to the west (outlined in blue below).
Illawarra-Shoalhaven Regional Plan 2041 (released May 2021)
The Regional Plan includes an Objective 2, Grow the regions regional cities. Nowra City Centre is one of the identified key centres and the Plan has a focus on activating and transforming the centre.
Action 2 in the Plan is: Develop a Nowra City Centre Strategic Roadmap to set a vision, identify actions and guide inter-agency and inter-government collaboration.
The NSW Department of Planning & Environment (DPE) has commenced early work on the ‘Roadmap’ and has engaged consultants to assist with this piece of work, that will involve engagement/consultation with landowners, retailers etc. Council staff will provide a verbal update on this work at the meeting and the Committee will be specifically consulted as this piece of work progresses.
DPE has also commenced early work on the South Nowra Employment Precinct Profile, which is another Regional Plan outcome
The Plan specifically identifies the Nowra Riverfront Precinct as a hub of activity and an ‘untapped asset’ under Strategy 2.1 Activate Nowra City Centre. The Plan Notes that the precinct could offer entertainment and leisure activities and there is a need to better connect the City Centre to the Riverfront.
More detail can be found here.
Previous Masterplan
Council previously adopted masterplan work for the precinct in late 2018 and the resultant ‘Proposed Planning Controls’ report was released in late 2019. The associated Strategic Directions report is available here. The work was prepared for Council by Studio GL.
During 2020 dialogue commenced with the NSW Department of Planning & Environment (DPE) regarding possible planning pathways for the precinct, acknowledging the need to resolve flooding concerns and consider the impact of the new Shoalhaven River Bridge and relationship to the adjacent medical precinct.
Nowra Riverfront Advisory Taskforce (NRAT) – Overview
The Nowra Riverfront Advisory Taskforce (NRAT) was established in November 2020 by the NSW Government and it is co-chaired by the NSW Department of Planning and Environment (DPE) and the Department of Regional NSW. The Taskforce is attended by Elected Members, the Mayor, Council staff, NSW Government Agency representatives and representatives of key interest groups.
The role of the Taskforce is to help ensure that the planning for the precinct is coordinated and aligned to other major projects underway, to identify and prioritise strategic development opportunities, and to drive the revitalisation of the precinct. The initial terms of Reference for the Taskforce are available here.
The Taskforce’s initial focus has been on identifying and undertaking the various planning studies and investigations that are needed to support future planning controls (including zoning and building heights) changes within the precinct to facilitate its revitalisation.
More information on the Taskforce and its work is also available on the following ‘Get Involved’ page, where people can also sign up to be kept informed regarding the broader project : https://getinvolved.shoalhaven.nsw.gov.au/nowra-riverfront
The following is a brief overview of relevant current outcomes and activities associated with the Taskforce and the precinct.
Studies
The following table identifies the various cultural and technical studies that have been co-funded by Council and the NSW Government and have recently been completed or are underway. The information gained from this work will inform a refined masterplan for the precinct and support any resultant land use planning changes.
Study |
Consultants |
Status |
Cross Cultural Framework |
Yerrabingin Pty Ltd. |
Underway Following ‘Connecting with Country’ Framework. Early work completed and stakeholder ‘Design Jam’ held in Feb 2023. |
Integrated Transport Strategy |
Crossley Transport Planning Pty Ltd |
Underway Movement and place assessment underway to identify issues, opportunities and define transport infrastructure requirements Under Bridge Access – application also submitted to NSW Government’s 2023/24 Get NSW Active Program for detailed design of this key active transport link. |
Flood Impact and Risk Assessment (FIRA) |
Rhelm Pty Ltd |
Underway Key initial piece of technical work given the flood profile of the precinct. Preliminary draft FIRA currently being discussed with NSW Government. |
Open Space Concept Design (central public open space) |
KI Studio Pty Ltd |
Completed The concept plus the outcomes of other relevant detailed studies will inform subsequent detailed design. |
Geotechnical / Acid Sulfate Soils / Contamination |
Stantec Pty Ltd. |
Completed Overall, no major issues detected Detailed/targeted investigations needed when future land use, configuration and design known. |
Utility Infrastructure Capability Assessment |
Stantec Pty Ltd |
Underway Considers electricity, water, sewer, stormwater, telecom and gas capacity. Assessments completed and report being finalised |
The following studies are yet to be commenced and are somewhat dependent on the outcomes of the initial studies:
· Urban Design Review
· Economic Feasibility Analysis
· Site-specific Cultural Heritage studies
· Non-Indigenous Heritage Review
· Traffic/Transport Plan
· Integrated Water Cycle Management Plan
· Graham Lodge – Conservation Management Plan
· Social Impact (Housing Affordability) Study
Other Supporting Pieces of work
Advocacy Projects 2023
Council’s Advocacy Projects 2023 document includes and highlights the Riverfront Precinct, noting the following:
The Shoalhaven Riverfront Precinct Project serves two key outcomes – connecting Nowra’s city centre to its beautiful river while elevating Nowra as the region’s civic, community, tourism and recreational hub.
The document is used to advocate to Government and others to consider helping fund or become involved in the projects, opportunities and the like identified in it. The 2023 document was distributed to a range of relevant parties ahead of the recent NSW Government Election.
Nowra Riverfront, Place Vision – with the assistance of Place Score Pty Ltd, NRAT has done some initial work on a ‘vision’ for the precinct, to help guide the work that is currently underway, that includes the following:
Early Community Engagement – Urban consultancy arki_lab are working on a range of community engagement opportunities with key stakeholders and the broader community to help inform a future masterplan for the precinct.
This work involved a ‘kick off’ information stall as part of the Nowra Bridge Walk on 23 February 2023 where Council staff, task force representatives and arki_lab staff talked to the community about future opportunities for the precinct. The stall was well attended, with over 300 comment postcards completed, and was the first in a series of opportunities for interested community members to share their thoughts and ideas.
The community engagement being run by aki_lab will generally involve the following opportunities:
The digital survey which is part of the above is currently open and will run until 31 March 2023. It can be accessed via the project ‘Get Involved’ page.
This Committee and its members have been identified as key stakeholders to involve in the ‘stakeholder workshop’ planned for 28 March 2023 from 4 till 6pm.
Conclusion
This is the first quarterly update report to this committee on the Riverfront Precinct that is being coordinated by the Nowra Riverfront Advisory Taskforce (NRAT). It covers the range of work that is underway in regard to the precinct. Further updated reports will be provided as the project progresses.
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.12 Update report - Community Mural Proposal - Laneway (Shoalhaven Regional Gallery) - 12 Berry St, Nowra
HPERM Ref: D23/96474
Department: Strategic Planning
Approver: Carey McIntyre, Director - City Futures
Reason for Report
This report provides an update on the proposal from Collator for a community mural event in the laneway adjacent to the Shoalhaven Regional Gallery (12 Berry Street, Nowra).
Options
1. As recommended.
Implications: The Committee will receive this update for information and will consider the detailed proposal, including funding request, at a future ‘e-meeting’ if necessary. This will enable Collator to move forward with the planning of the event and mural proposal in a timely manner.
2. Adopt an alternate recommendation.
Implications: Will depend on the nature of an alternate recommendation but could delay the planning of the event and mural proposal.
Background
On 14 September 2022 the Committee considered a proposal from creative arts facilitator Collator seeking funding from the Committee towards a community mural event in the laneway adjacent to the Shoalhaven Regional Gallery (item CBD22.28). The proposal aims to engage with local young people and activate a space in the CBD. At this stage an indicative date for the mural event is late June/early July.
The Committee resolved to:
1. Provide ‘in-principle’ support to the proposed community mural event in the Laneway adjacent to Shoalhaven Regional Gallery (12 Berry St, Nowra).
2. Receive a further report at the appropriate point to consider the detail (budget request, resourcing, community engagement etc).
Collator were invited to submit a detailed proposal and funding request for the community mural and event. This was received in early February 2023. Council staff subsequently discussed it with Collator and suggested further updates/adjustments to help clarify certain details.
Collator is now expected to submit the revised proposal in late March. Depending on the receipt of the information, the matter will be the subject or a verbal report to this meeting or if need be and the Committee is agreeable, the proposal will be reported back to the Committee to consider at an ‘e-meeting’ if necessary to enable planning for the event and mural proposal to move forward in a timely manner.
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.13 Standing Report - Budget Update - March 2023
HPERM Ref: D23/102479
Department: Technical Services
Approver: Craig Exton, Manager - Technical Services
Attachments: 1. Attachment - CBD Budget Update - March 2023 ⇩
Reason for Report
To provide an update on the Nowra CBD Revitalisation Strategy Committee Budget.
Background
This report provides an update to the Nowra CBD Revitalisation Strategy Committee budget spending compared to the 3-year action plan that was endorsed by Council on 20 July 2021 (MIN21.540). A summary of the Budget is attached.
On 8 March the Nowra CBD Revitalisation Strategy Committee Chair, Clr White, the Nowra CBD Place Manager along with Council Staff, Acting Director City Services and Manager Design Services met for a budget review. The purpose of the review was to identify action items with budgets that could not realistically be spent this financial year and move them to next year. The main reason for the expenditure being unable to be completed was not having a place manager for the full financial year. In the attached budget summary, the original yearly forecast is shown in blue and labelled Original Budget’ and the revised budget is labelled ‘Revised March Budget.
Previously the CBD Promotions and Activation fund was shown in addition to the Nowra CBD Revitalisation Strategy Committee allocation ($500,000 plus indexation). This is an error as the CBD Promotions and Activation fund should come out of the Nowra CBD Revitalization Strategy Committee allocation ($500,000 plus indexation). This has been rectified.
Expenditure
Name |
Paid to |
Amount (Excl GST) |
Face Painting – Easter Event |
Purple Possum Face Painting |
$500 |
Security – Christmas Event |
Insight Security Australia |
$21,730 |
CBD Place Manager |
Alison Peta Henry |
$15,600 |
Total |
$37,830 |
Income
Nil
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.14 Standing Report - Project Update - March 2023
HPERM Ref: D23/102499
Department: Technical Services
Approver: Craig Exton, Manager - Technical Services
Reason for Report
To provide the Nowra CBD Revitalisation Strategy Committee with an update on nominated projects within Nowra CBD.
Recommendation (Item to be determined under delegated authority) That the Nowra CBD Revitalisation Strategy Committee note the update provided on the nominated projects within the Nowra CBD.
|
Background
The following projects are funded by the Nowra CBD Revitalisation Strategy Committee. Updates on each of the below projects will be provided at meetings of the Nowra CBD Revitalisation Strategy Committee:
· Feasibility Investigation - Use of Smart Poles in the Nowra CBD
· Investigation & Design - Pedestrian Crossing - Junction Street Nowra
· Traffic Masterplan for North Street, Nowra
· Nowra CBD Action Plan
The following projects are funded by Council. The Nowra CBD Revitalisation Strategy Committee has requested a short update on the below projects at meetings of the Committee:
· Nowra Arts Centre - Roof Renewal Works
· Nowra CBD - All Day Car Parking
· Nowra - O'Keeffe Avenue
· Nowra - Berry / Worrigee Street – Multi Storey Car Park - Investigate and Design
· Nowra - Bridge Rd / Hyam St Intersection - Safer Roads Project
· Nowra - Berry St / Worrigee St – Intersection Upgrade Traffic Lights (Design)
· Council Admin Building Works
The following projects have been added to the projects update list as a result of Nowra CBD Revitalisation Strategy Committee meeting resolutions:
· Morrisons Arcade lease renewal and lighting (CBD21.40)
· CBD Mural Project (CBD21.44)
· Jellybean Park Electrical and Technology Infrastructure Upgrade (CBD22.9)
Project Updates
1. Feasibility Investigation - Use of Smart Poles in the Nowra CBD
Complete Urban has been engaged to undertake the feasibility investigation for $10,190 excl GST. The work has been completed and a way forward will be the subject of a future report to the Nowra CBD Revitalisation Strategy Committee.
2. Investigation & Design – Pedestrian Crossing – Junction Street, Nowra
Budget - $5,000.
A design is complete and grant funding has been secured for construction.
3. Traffic Masterplan for North St, Nowra
Budget - $60,000.
Cardno consultants have been engaged for concept design and costing. The initial work is complete with additional scope being considered.
Alison Henry has been appointed Nowra CBD Place Manager.
5. Nowra Arts Centre - Roof Renewal Works
Project has been deferred due to variations associated with the works on the library air conditioning.
6. Nowra CBD - All Day Car Parking
This project is split into 2 sub projects.
Berry St, Nowra-Carpark Extension – Construction is underway and due for completion in Q3.
Burr Ave, Nowra – Construction planned Q4.
7. Nowra - O'Keeffe Avenue
This project is for the signalisation of the existing pedestrian crossing between Coles and the Ex-Servos. The Project has a budget of $289,000. Construction is currently underway.
8. Nowra - Berry/Worrigee Street - Multistorey Car Park - Investigate and Design
This Project is to design a multi storey carpark at the corner of Berry St and Worrigee St. The Civil and Structural Design has been completed. Electrical designs are ongoing. Easement requirements are progressing. The construction is currently unfunded.
9. Nowra - Bridge Rd / Hyam St Int - Safer Roads Project
This Project is for the design of Traffic Lights at the Intersection of Bridge Rd and Hyam St, Nowra. This project is reliant on grant funding. To date Council has been unsuccessful in obtaining grant funding and the project is on hold.
10. Design of Traffic Lights at the Intersection of Worrigee St and Berry St, Nowra.
This project is reliant on grant funding. To date Council has been unsuccessful in obtaining grant funding and the project is on hold.
11. Council Admin Building Works
Upgrade to Level 3 Accessible Amenities – Provide additional accessible amenities – Budget - $150,000 – Complete
Fire Mitigation Upgrade – To improve the administration buildings fire safety measures– Budget $1,010,000 – Task 1 - Attaining existing fire schedule compliance Certification & Compliance have issued revised Fire Safety Schedule (FSS) for review prior to issuing formally through a Fire Safety Order (FSO). Task 2 - Draft NISO (2) has been issued by Certification & Compliance for commission of a Fire Engineering Report (FER). Review and feedback provided on 7 April 2002. Expecting Fire Safety Order to be issued 20 May 2022. Revised date pending. The FER will define exact scope of building fire upgrades. Works continuing on combined fire water supply, system commissioning planned 13 July 2022.
12. Morrisons Arcade lease renewal and lighting
The lease for the Morrisons Arcade airspace is due for renewal on 14 June 2023. Lease renewal work commenced in January 2023 with the intention of Council taking control and responsibility for the lighting in the public throughfare.
13. CBD Mural Project
Budget - $55,000.
A mural on the building at 11 Haigh Avenue, Nowra has been completed.
14. Jellybean Park Electrical and Technology Infrastructure
Festoon lighting and additional power outlets have been provided. This was funded by the residual of the Your High Street Grant.
A variation application has been approved by the grant funding body to provide additional power outlets on the other side of Jellybean Park, replace light globes in Junction Street and provide a pedestrian crossing in Junction Street. The light globes replacement in Junction St is complete. Additional power outlets in Jellybean Park is also complete.
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.15 Proposal - 16 Berry Street Nowra
HPERM Ref: D23/107729
Department: Technical Services
Approver: Craig Exton, Manager - Technical Services
Reason for Report
To allow the Nowra CBD Revitalisation Strategy Committee to consider providing funding towards the demolition of 16 Berry St, Nowra.
Options
1. The Nowra CBD Revitalisation Strategy Committee could choose not to contribute funds toward the demolition of 16 Berry Street, Nowra.
Implications: The building at 16 Berry Street would remain in place for the foreseeable future with only minor safety improvements undertaken as the full demolition is unfunded.
– Gary George will provide a presentation on the proposed demolition of 16 Berry St, Nowra.
|
Nowra CBD Revitalisation Strategy Committee – Tuesday 04 April 2023 Page 1 |
CBD23.5 Discussion Item - Future Character of New Builds in Nowra CBD
HPERM Ref: D23/7583
Submitted by: Clr Tonia Gray
Recommendation (Item to be determined under delegated authority) That the report be submitted for consideration and received for information. |
Details
As we redefine the CBD future character on medium to high density buildings, the liveability of the city needs to take precedence. Based on pioneering work in Melbourne e.g. 269 Stewart St East Brunswick, Melbourne. http://thestewartcollective.com.au/
Developments can become aspirational and more liveable and achieve a 7.5-star rating. Achieving a high star rating means less energy is required to keep interiors at a comfortable climate, in any season. The by-products are lower bills and a reduced environmental footprint.
Set beside CERES Community Environment Park and the Merri Creek Trail, the collection of residences introduce refined, yet raw architectural design saturated in greenery and sunlight. Perfectly placed in a quiet residential street with direct access to CERES (a community garden which is a community hub for produce). Homes/units are designed on a personal scale with great environmental integrity. The sustainable initiatives are a serious commitment to offer better choices.
Features also include underground secure car space, communal rooftop garden, communal library and communal on site bike storage.
Here is an example: https://lucentgroup.com.au/projects/stewart-collective.html
Brand New 2 Bedroom 2 Bathroom Apartment
With sizable west facing terrace balcony, the interiors have everything you need to live well, and nothing you don’t need. The interiors think of all types of people and how they will want to live in spaces of true quality. With hard wearing, durable surfaces, make you feel right at home the moment you walk in.
The layout has 2 bedrooms (master with walk in robe and ensuite) main bathroom with walk in shower, that makes thoughtful use of generous spaces, and have interchangeable living aspects. Large stylish kitchen with island bench, open plan dining /lounge room with floor to ceiling windows.
Delivery Plan / Operational Plan – Reference Heading
Priority 1.1 – Resilient, Safe, Accessible & Inclusive Communities and 2.1 – Sustainable, Liveable Environments
Budget Implications and Resourcing Strategy Implications
Nil
Terms of Reference / Delegation
N/A
Policy Context
