Rural Fire Service Strategic Planning Committee

Meeting Date:     Thursday, 15 February, 2018

Location:            Council Chambers, City Administrative Centre, Bridge Road, Nowra

Time:                   6.00pm

Please note: Council’s Code of Meeting Practice permits the electronic recording and broadcast of the proceedings of meetings of the Council which are open to the public. Your attendance at this meeting is taken as consent to the possibility that your image and/or voice may be recorded and broadcast to the public.

Agenda

1.    Apologies

2.    Confirmation of Minutes

·      Rural Fire Service Strategic Planning Committee - 30 November 2017..................... 1

3.    Reports

RF18.1........ RFS Infrastructure Preface........................................................................... 11

RF18.2........ Other RFS Infrastructure Projects................................................................ 13

RF18.3........ Kangaroo Valley Station Additions............................................................... 16

RF18.4........ Shoalhaven Heads Extensions.................................................................... 18

RF18.5........ Kioloa Station Extensions............................................................................. 20

RF18.6........ IEMC "Pad Mount" Transformer................................................................... 22

RF18.7........ Tabourie Station Extensions........................................................................ 23

RF18.8........ Broughton Vale / Berry Rural Fire Station.................................................... 24

RF18.9........ Currarong Station Additions......................................................................... 73

4.    General Business

RF18.10...... Work Health & Safety (WH&S)

RF18.11...... Code of Conduct

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page ii

Membership

Clr Mitchell Pakes – Chairperson

Clr Mark Kitchener

Clr Jo Gash

Mr Russ Pigg or nominee (Mr Paul Keech)

Mr Mark Williams

Mr Paul Gooey

Ms Jennifer Lawther (Alternate TBA)

Mr Andrew Fielding (Alternate – Mr Bob Johnston)

Mr Vic Walker (Alternate – Ms Jacqui Cox)

Mr Martin Gaffey (Alternate – Mr Ron Rollinson)

Mr Paul Gleeson (Alternate – Mr Geoff Phillips)

Mr John Ashton (Alternate – TBA)

Mr Bill Bean (Alternate – TBA)

Mr Chris Baseler or nominee

Quorum - Five (5)

Objectives:

To advise Council on issues of a strategic and policy nature relating to the operation of the Rural Fire Services having regard to the following:

·           That the core communication between brigades and Fire Control Officer on operational issues be raised through the Group Officers utilising the committee structure.

·           All issues be raised through Fire Control so that statutory matters can be resolved immediately.

·           Policy matters raised can be referred to the Strategy and Assets Committee through the General Manager so that statutory matters can be resolved.

·              That the Strategic Planning Committee be developed as the body advising Council on Rural Fire Service policy issues

Minutes of the Rural Fire Service Strategic Planning Committee

Meeting Date:     Thursday, 30 November 2017

Location:            Council Chambers, City Administrative Centre, Bridge Road, Nowra

Time:                   6.00pm

The following members were present:

Clr Mitchell Pakes - Chairperson

Clr Mark Kitchener

Mr Mark Williams – District Manager, Shoalhaven Rural Fire Service

Mr Paul Gooey

Ms Jennifer Lawther

Mr Andrew Fielding

Mr Martin Gaffey

Mr Paul Gleeson

Mr John Ashton

Mr Peter Knill – Acting Director Assets & Works

Others present:

Clr Patricia White

Ms Megan Birmingham – Shoalhaven City Council

Ms Lynda Ho – Shoalhaven City Council

Mr Michael Strachan – Shoalhaven City Council

Apologies / Leave of Absence

Apologies were received from Messrs Bill Bean, Paul Keech, Ron Rollinson and Vic Walker.

The Committee welcomed Clr Mitchell Pakes, incoming Chairperson and Mr Peter Knill, Acting Director, Assets & Works (for Mr Paul Keech).

At its meeting on 29 September 2017, Council appointed Clr Mitchell Pakes (Chairperson), Clr Joanna Gash and Clr Mark Kitchener to the Committee.

Confirmation of the Minutes

RESOLVED (Andrew Fielding / Paul Gooey)

That the Minutes of the Rural Fire Service Strategic Planning Committee held on Thursday 11 May 2017 be confirmed.

CARRIED

Declarations of Interest

Clr Mitchell Pakes – All reports – significant non pecuniary interest declaration – Member of the RFS – remained in the room and did not take part in discussion or vote.

Reports

RF17.24     Proposed Dates for Meetings in 2018

HPERM Ref: D17/383909

Recommendation (Item to be determined under delegated authority)

That the Committee adopt the proposed meeting dates for 2018.

RESOLVED (Mark Williams / Jennifer Lawther)

That the Committee adopt the following meeting dates for 2018:

1.      5.30pm Thursday 8 February

2.      5.30pm Thursday 10 May

3.      5.30pm Thursday 9 August

4.      5.30pm Thursday 8 November

CARRIED

RF17.25     RFS Infrastructure Preface

HPERM Ref: D17/359762

Recommendation (Item to be determined under delegated authority)

That the Committee recieves the report for information.

RESOLVED (Mark Williams / Paul Gooey)

That the Committee recieves the report for information.

CARRIED

RF17.26     Other RFS Infrastructure Projects

HPERM Ref: D17/359833

Status of Infrastructure projects

The following projects will remain in the Shoalhaven Strategic Capital Expenditure Program, but were unfunded: Training/Logistics/SMSS Facility (TLSF); Wandandian Station extensions; Basin View Station extensions; Conjola Station extensions; Beaumont Station extensions, and Huskisson Station extensions.

Manyana Brigade

The Bendalong/Cunjurong Point brigades had been amalgamated and the inaugural Manyana RFB Annual General Meeting was held on 18 October 2017.  The Fire Control Officer was pleased to see the new brigade “getting on with it”.  Mr Paul Gleeson and both brigades were thanked for facilitating the amalgamation process.

2017/18 RFFF Allocation

Although the funding allocation had occurred some time ago the outcome hadn’t been reported due to a meeting being cancelled and another being rescheduled.

It was highlighted that:

·         A bid for $300,000 for a new “Pod” Logistics vehicle had been unsuccessful.  The Fire Control Officer would try to get the item into the budget for the mid or following year;

·         Approximately $2 Million had been carried over for infrastructure projects, and

·         A bid for approximately $1,000,000 was unsuccessful due to a lack of expenditure of current allocation of $2 Million.

Staff Movements

The Committee requested a letter be written to James Morris thanking him for his service and congratulating him on his new appointment.

Joshua Gregory will be joining the RFS, commencing 15 January 2018, having been a member of the Culburra RF brigade and an air force fire fighter.

Recommendation (Item to be determined under delegated authority)

That the Committee receives the report for information.

RESOLVED (Mark Williams / Paul Gooey)

That the Committee writes a letter to James Morris thanking him for his service and congratulating him on his new appointment.

CARRIED

RESOLVED (Mark Williams / Martin Gaffey)

That the Committee receives the report for information.

CARRIED

RF17.27     IEMC 92 Albatross Road, South Nowra Master Plan

HPERM Ref: D17/359848

Frustration was expressed at the length of time taken to secure the subdivision of the Dog Track Road as a public road and access point for the IEMC.  It was noted that :

  • The Fire Control Officer disagreed with the statement in Council’s report that “The delay in resolving the road status is not impacting on RFS operation”.  Fire trucks routinely used the Dog Track Road, sometimes in emergency situations. It was queried if Council would provide an assurance and accept liability in the event of an accident.
  • Michael Strachan advised practical access was currently available to fire trucks via the Dog Track road.  There was a difference between practical and legal access.  There were many roads in the Shoalhaven that did not follow the legal alignment.
  • The FCO noted that the recently awarded DA for the SLS facility shows access through the West Nowra RFB Station carpark, and stated that this is not acceptable or practical and in reality, they too will ultimately need to use Dog Track Road.
  • Council had the option of negotiating with Crown Lands to have the land dedicated as a public road or compensating Crown Lands for the land.  Clr Pakes undertook to take the matter up with Business & Property.

Recommendation (Item to be determined under delegated authority)

That Council report to the Committee the status of the sub division of “Dog Track Rd” and pursue this to completion as a matter of priority.

RESOLVED (Mark Williams / Andrew Fielding)

That Council report to the Committee the status of the sub division of “Dog Track Rd” and pursue this to completion as a matter of priority.

CARRIED

RF17.28     West Nowra Rural Fire Station

HPERM Ref: D17/359877

The Fire Control Officer disagreed with the statement in Council’s report that “Timing of this project [IEMC pad mount transformer] is not impacting on operation of the Brigade premises”.  The RFS were currently operating from a temporary supply and could not use the air conditioner, 3 phase power and washing machine

Recommendation (Item to be determined under delegated authority)

That Council expedites the installation and connection of the Pad Mount transformer and connection of permanent power to the WNFS so as all electrical installations can be utilised.

RESOLVED (Mark Williams / Paul Gleeson)

That Council expedites the installation and connection of the Pad Mount transformer and connection of permanent power to the WNFS so as all electrical installations can be utilised.

CARRIED

RF17.29     Kangaroo Valley Station Additions

HPERM Ref: D17/359893

The Fire Control Officer expressed frustration at the length of time taken for the Kangaroo Valley station additions to reach the DA stage, specifically the issues relating to flood planning requirements and the height restriction issue.  The 28 November 2017 Council meeting resolved to proceed with the enhancement of the current Kangaroo Valley RFS Station despite the planning issues associated with the station being in a flood zone.

Concern was expressed that the funding may be lost if the works didn’t substantially commence in the next 6 months.  The Fire Control Officer urged P&DS staff to resolve the remaining height issue, with expedience.

Recommendation (Item to be determined under delegated authority)

1.    That the Committee requests Council to support the current site proposal plans as developed by Council in consultation with RFS management and the Kangaroo Valley Brigade.

2.    That the Committee requests Council’s development services submit the DA to Council’s next meeting for determination so that the project can be progressed as a matter of urgency.

RESOLVED (Mark Williams / Paul Gleeson)

1.    That the Committee requests Council to support the current site proposal plans as developed by Council in consultation with RFS management and the Kangaroo Valley Brigade.

2.    That the Committee requests Council’s development services submit the DA to Council’s next meeting for determination so that the project can be progressed as a matter of urgency.

.CARRIED

RF17.30     Shoalhaven Heads Extensions

HPERM Ref: D17/359905

The Fire Control Officer advised that a DA for the Shoalhaven Heads Station extension had been submitted in September and the recommendation sought endorsement for transferring funds from the Currarong Station project to allow the Shoalhaven Heads extension to proceed.

Other issues had emerged with the Shoalhaven Heads Station extension that were expected to delay the works.  The driveway to the current Shoalhaven Heads Fire Station was on Crown land and likely to be subject to the “blanket” Native Title claim.  These issues would require considerable time to resolve.

The Fire Control Officer raised the possibility of the funding being lost if the works didn’t commence before the end of financial year.

The Committee added a third point to the recommendation to provide for Council to report to the Committee on the expected timeframe for resolving the driveway-related land issues.

Recommendation (Item to be determined under delegated authority)

That

1.    the Committee endorses the project as planned and also the proposal to seek a transfer of the shortfall of funds from the Currarong Station project (item RF17.33) to allow for completion of this project.

2.    the Committee seeks a commitment from Council on the DA approval timeframe.

RESOLVED (Mark Williams / Jennifer Lawther)

That

1.    the Committee endorses the project as planned and also the proposal to seek a transfer of the shortfall of funds from the Currarong Station project (item RF17.33) to allow for completion of this project.

2.    the Committee seeks a commitment from Council on the DA approval timeframe.

3.    Council report to the Committee on the expected timeframe for clarifying the driveway (Crown Land) matter.

CARRIED

RF17.31     Kioloa Station Extensions

HPERM Ref: D17/359919

The Fire Control Officer sought endorsement for a transfer of funds from the Tabourie Station project (not Currarong as stated in the agenda recommendation) to allow the Kioloa Station extension to proceed.  The recommendation was corrected. The Kioloa Station extension also required an $35,000 fund transfer from the Broughton Vale station seed funding to succeed (refer to RF17.34).

RFS members were pleased with the progress reported in Council’s report on these works.

Recommendation (Item to be determined under delegated authority)

That

1.    the Committee endorses the project as planned and also the proposal to seek a transfer of the shortfall of funds from the Tabourie Station project (item RF17.32) to allow for completion of this project.

2.    the Committee seeks a commitment from Council on the DA approval timeframe

RESOLVED (Mark Williams / Paul Gleeson)

That

1.    the Committee endorses the project as planned and also the proposal to seek a transfer of the shortfall of funds from the Tabourie Station project (item RF17.32) to allow for completion of this project.

2.    the Committee seeks a commitment from Council on the DA approval timeframe

CARRIED

RF17.32     Tabourie Station Extensions

HPERM Ref: D17/360023

As noted under item RF17.31, $150,000 currently allocated to this project will be used for the Kioloa Fire Station extensions and the remaining $30,000 will be used to progress the project through the DA approval.  In the meantime, Council would continue to progress the Native Title Land claim and rezoning issues.

The Fire Control Officer emphasised the need to have projects “shovel ready” prior to seeking funding.

Recommendation (Item to be determined under delegated authority)

That

1.      the land use agreement is progressed and formalised

2.      the DA for the project be submitted to Council for determination

3.      $30,000 of the funds currently allocated be used to progress to DA completion.

4.      the District Manager make application to the RFS for the remaining portion of the funds ($150,000) currently allocated to the project be re-allocated to the Kioloa RFB station (item 5) addition/refurbishment to permit its completion.

5.   full funding for the completion of the project be included into the 2018/19 RFFF estimates.

RESOLVED (Mark Williams / Andrew Fielding)

That

1.      the land use agreement is progressed and formalised

2.      the DA for the project be submitted to Council for determination

3.      $30,000 of the funds currently allocated be used to progress to DA completion.

4.      the District Manager make application to the RFS for the remaining portion of the funds ($150,000) currently allocated to the project be re-allocated to the Kioloa RFB station (item 5) addition/refurbishment to permit its completion.

5.      full funding for the completion of the project be included into the 2018/19 RFFF estimates.

CARRIED

RF17.33     Currarong Station Additions

HPERM Ref: D17/360052

Commentary provided under item RF17.30

Recommendation (Item to be determined under delegated authority)

That

1.    The Committee endorses the District Manager to seek the transfer of funds allocated to this project to the Shoalhaven Heads RFB station project to allow for its completion.

2.    The Committee endorses the District Manager to apply for seed funding for this project in the 2018/19 RFFF estimates to bring the project to fully costed DA status.

3.    The Committee recommends to Council that once seed funding is allocated, that NSW Department of Public Works be appointed as the principal contractors for this project

RESOLVED (Mark Williams / Paul Gooey)

That

1.    The Committee endorses the District Manager to seek the transfer of funds allocated to this project to the Shoalhaven Heads RFB station project to allow for its completion.

2.    The Committee endorses the District Manager to apply for seed funding for this project in the 2018/19 RFFF estimates to bring the project to fully costed DA status.

3.    The Committee recommends to Council that once seed funding is allocated, that NSW Department of Public Works be appointed as the principal contractors for this project.

CARRIED

RF17.34     Broughton Vale / Berry Rural Fire Station

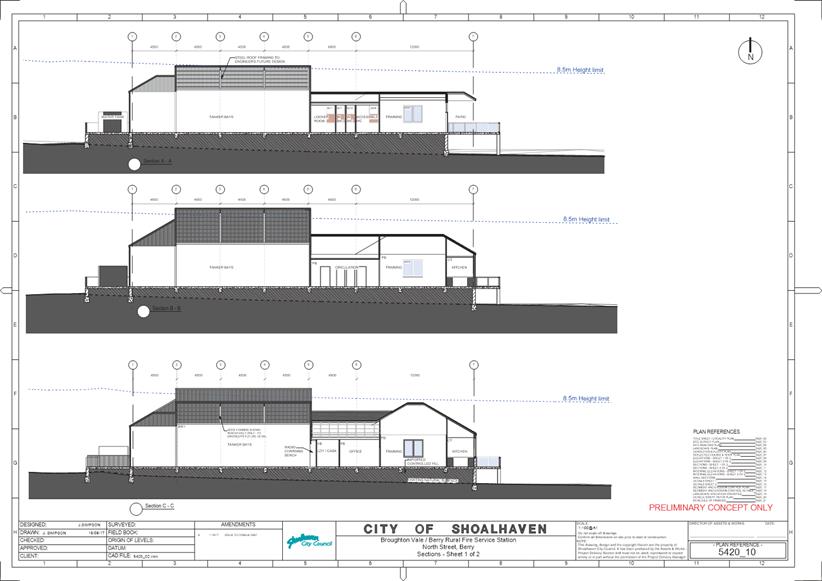

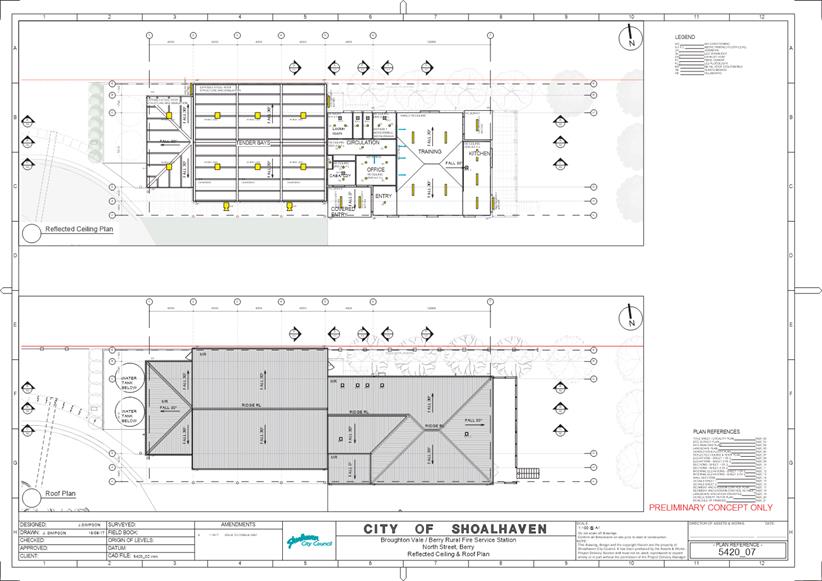

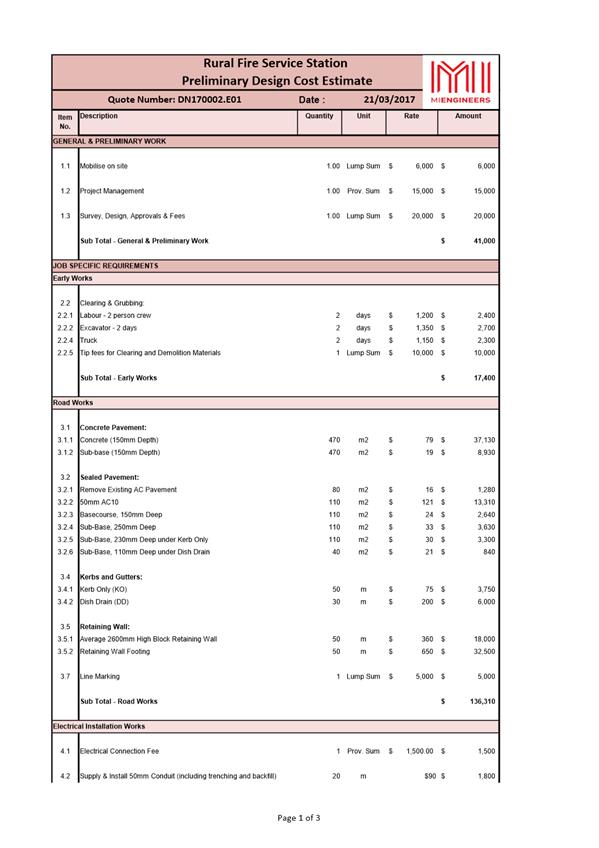

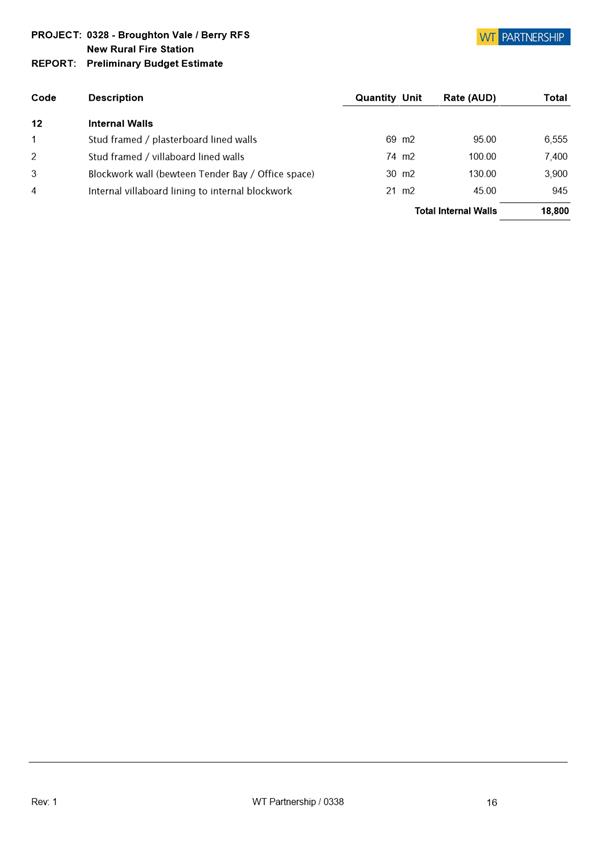

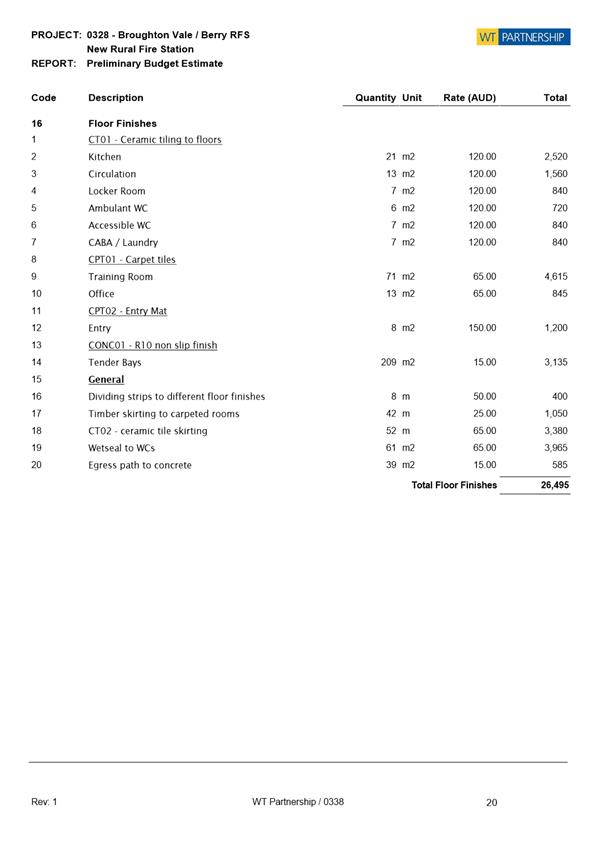

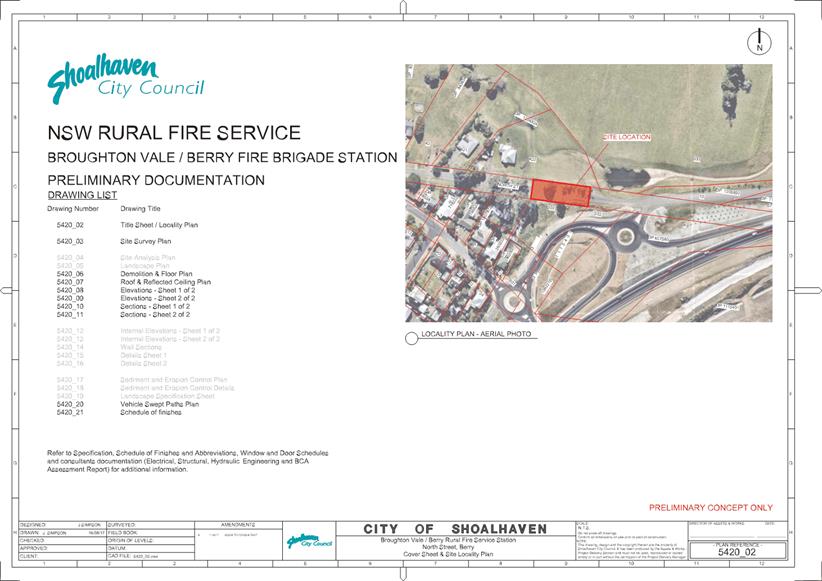

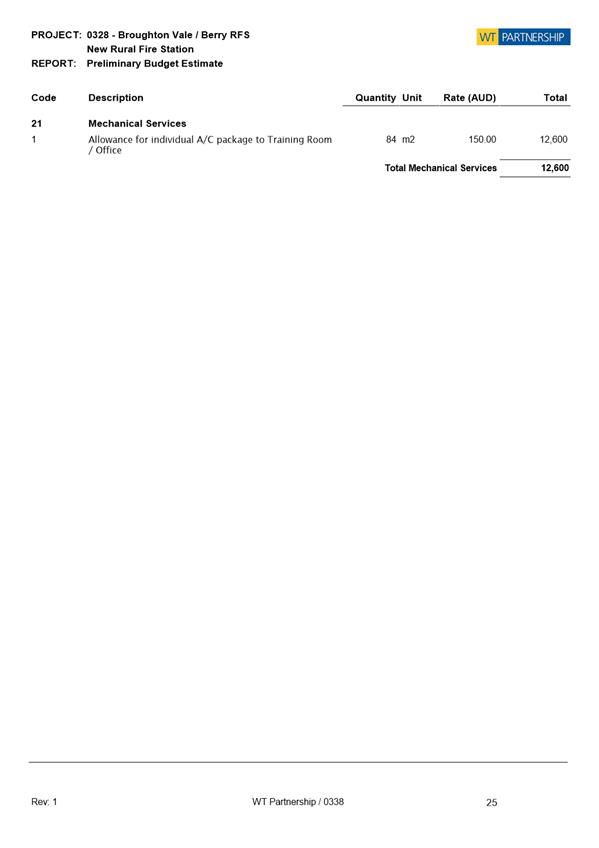

HPERM Ref: D17/360088

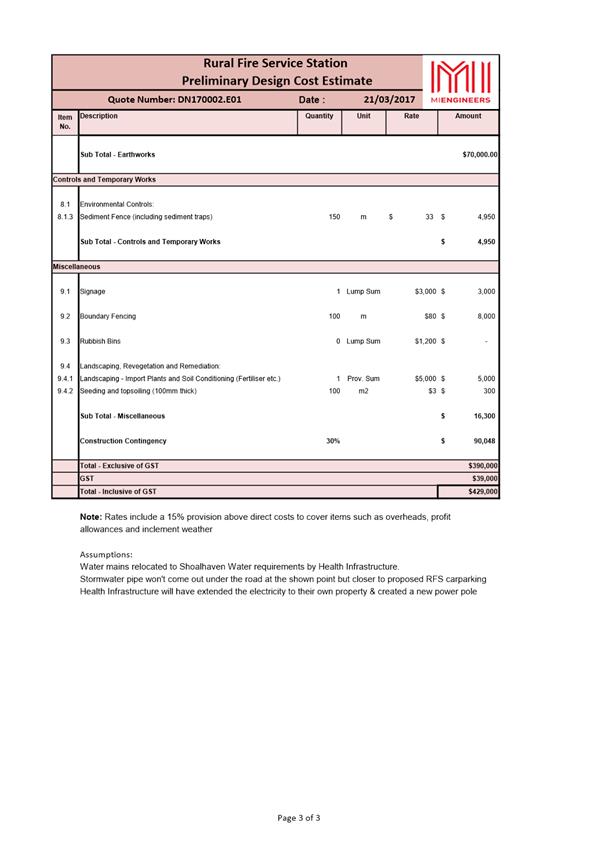

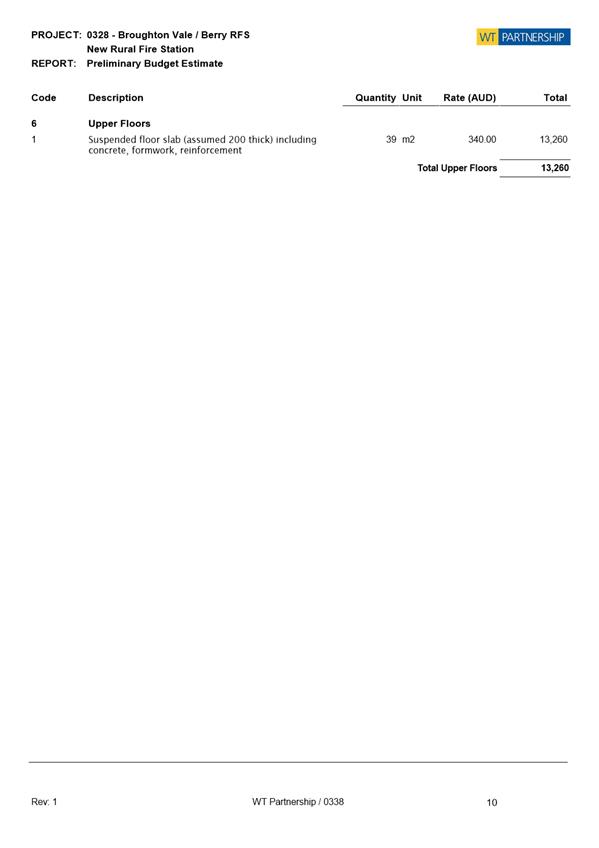

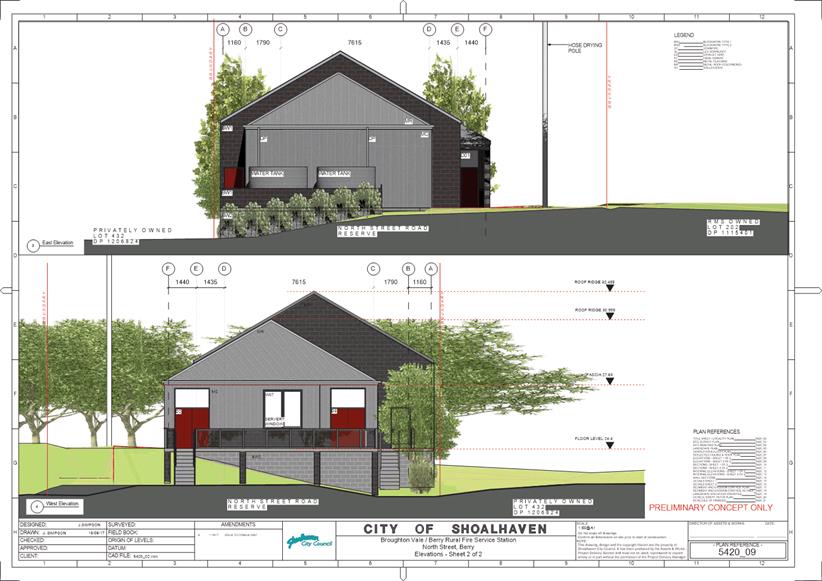

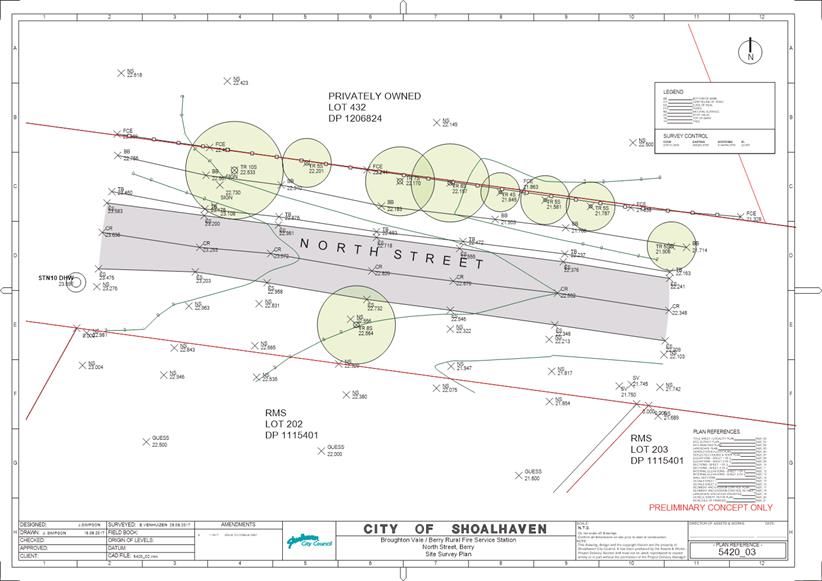

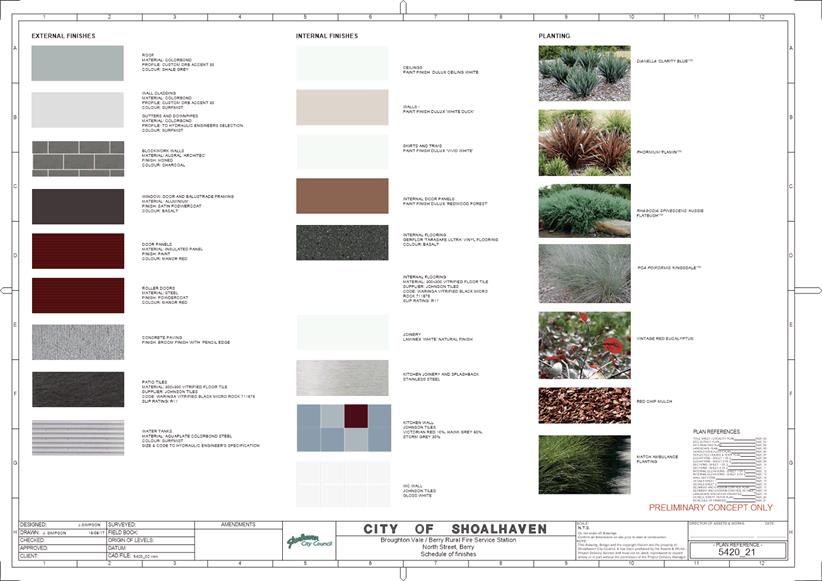

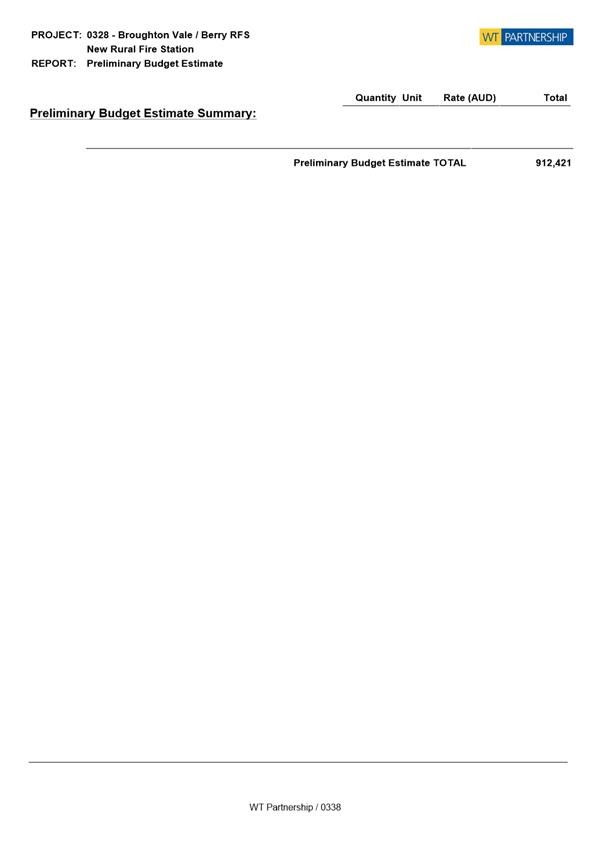

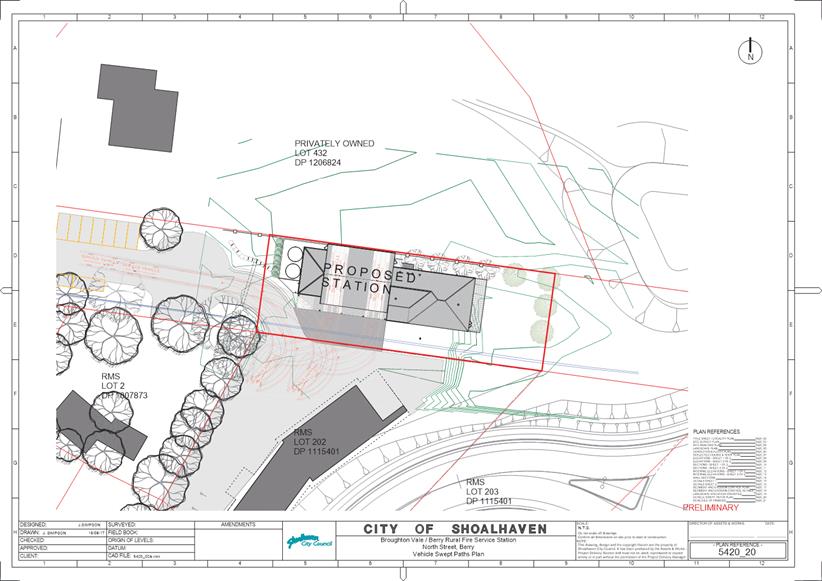

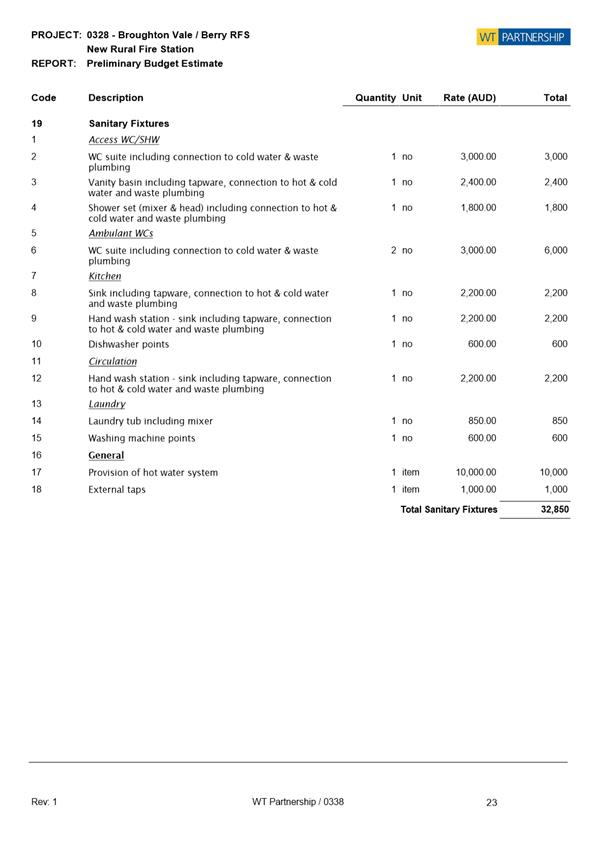

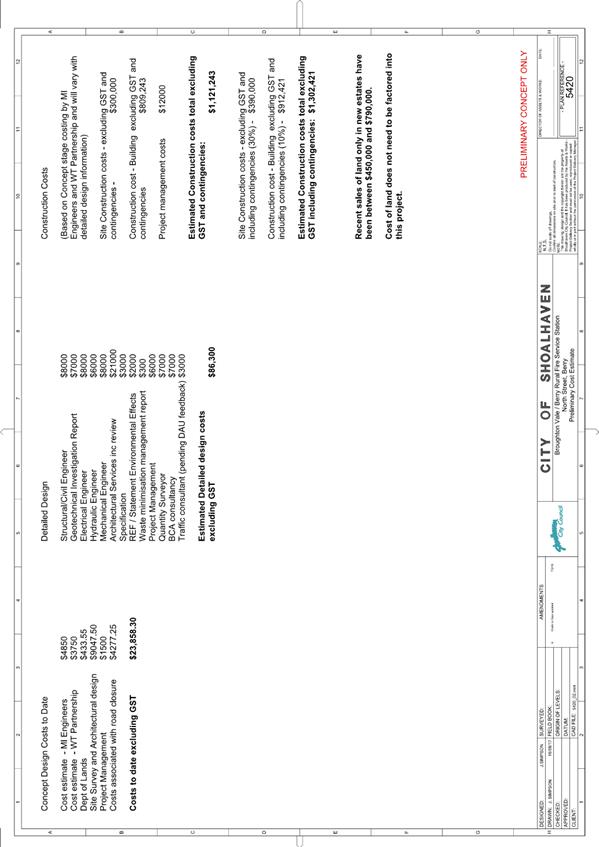

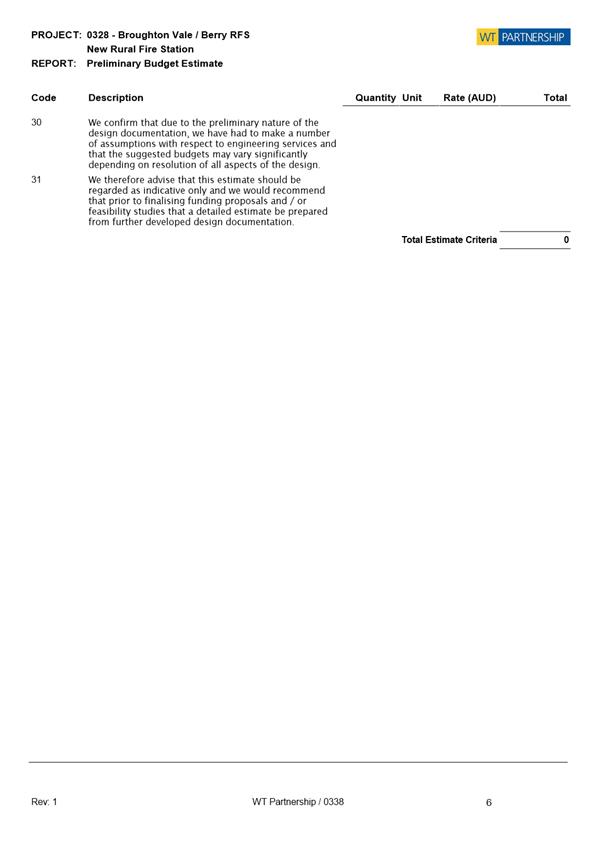

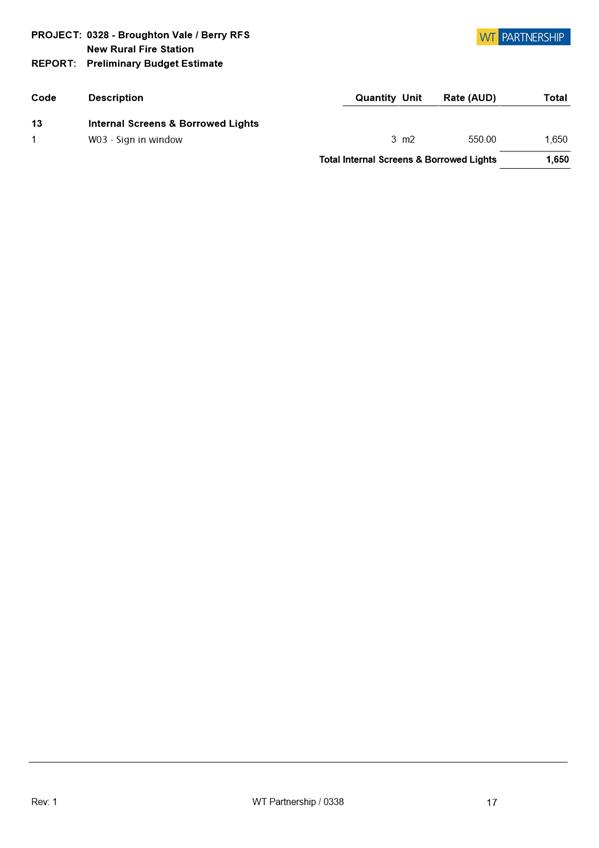

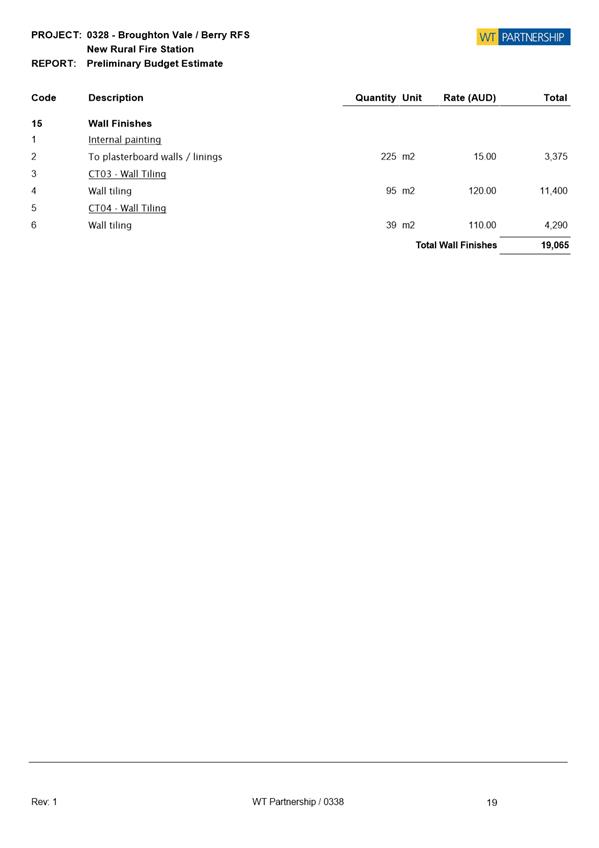

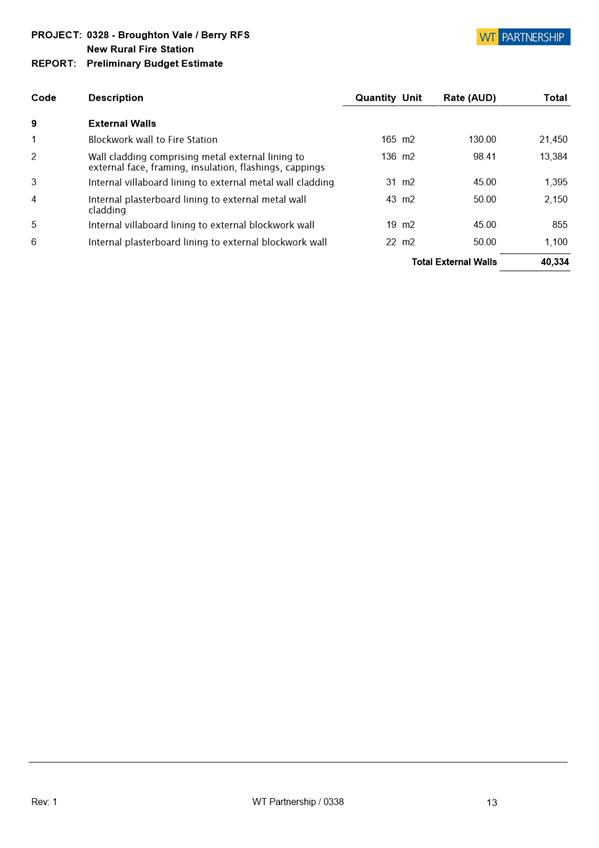

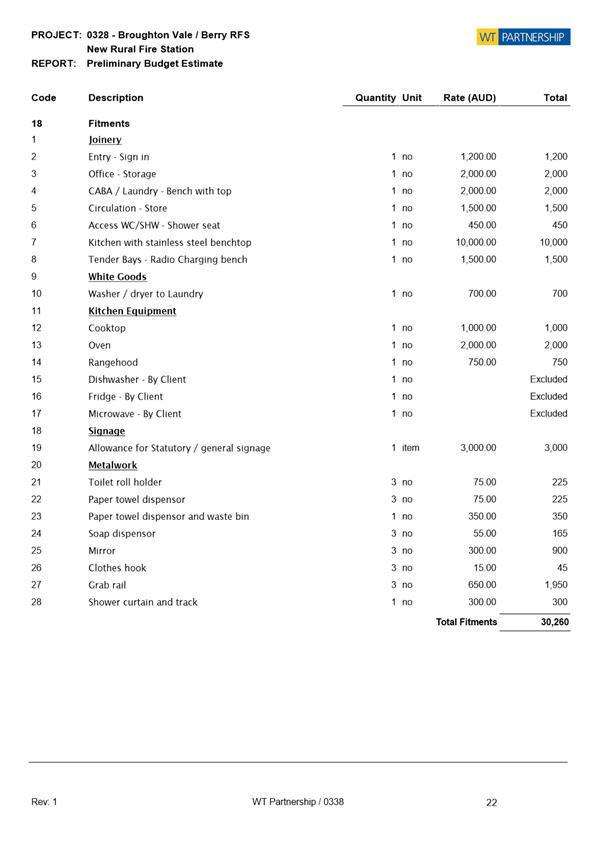

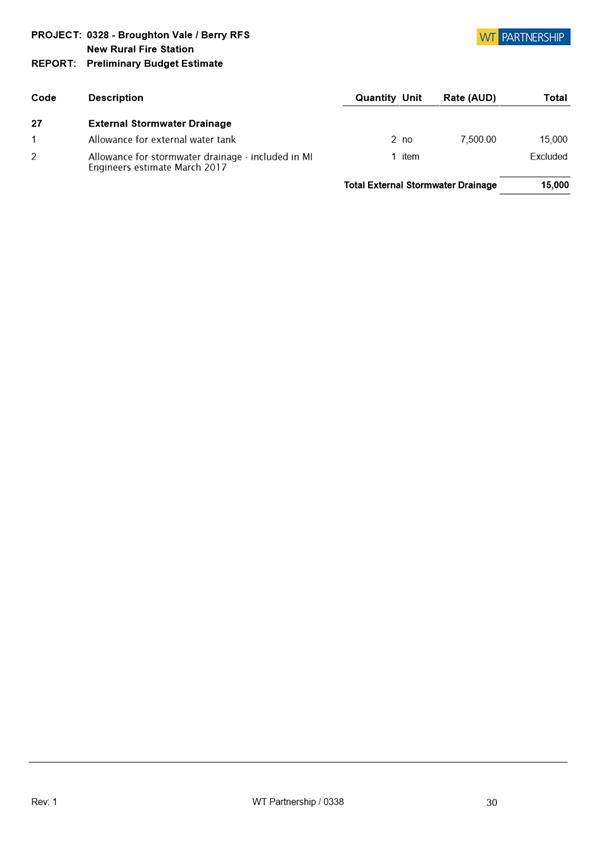

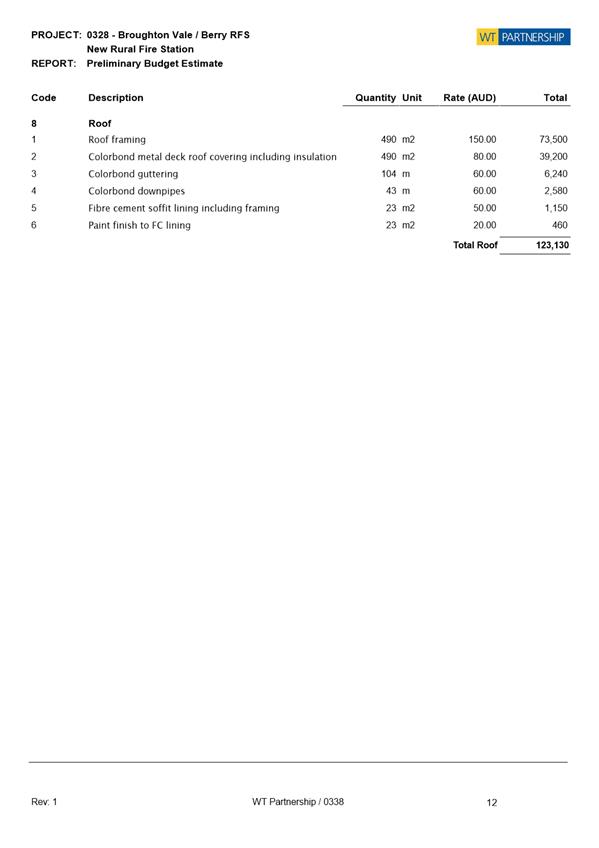

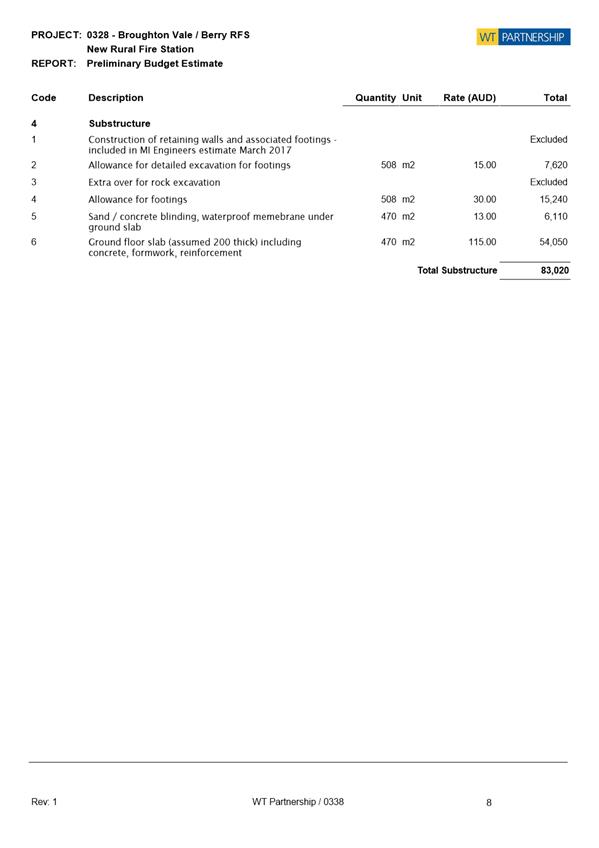

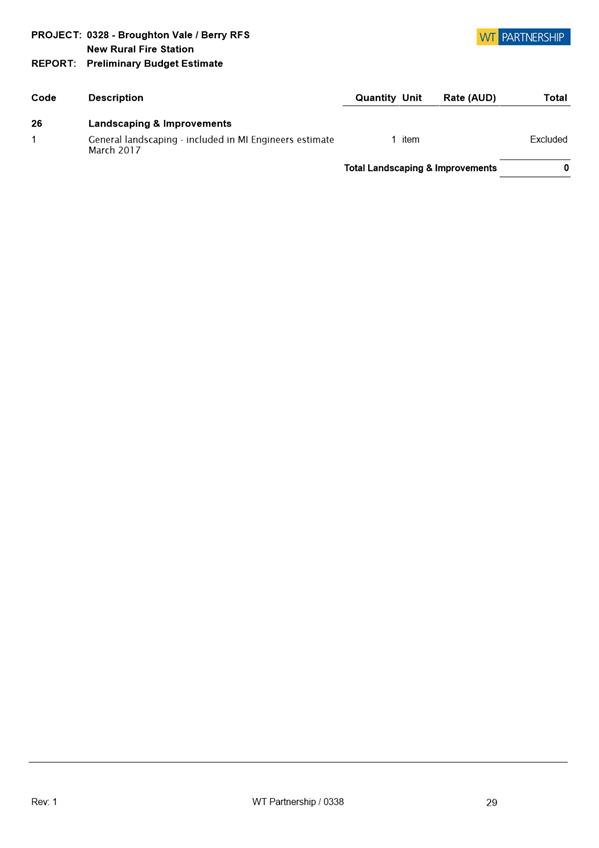

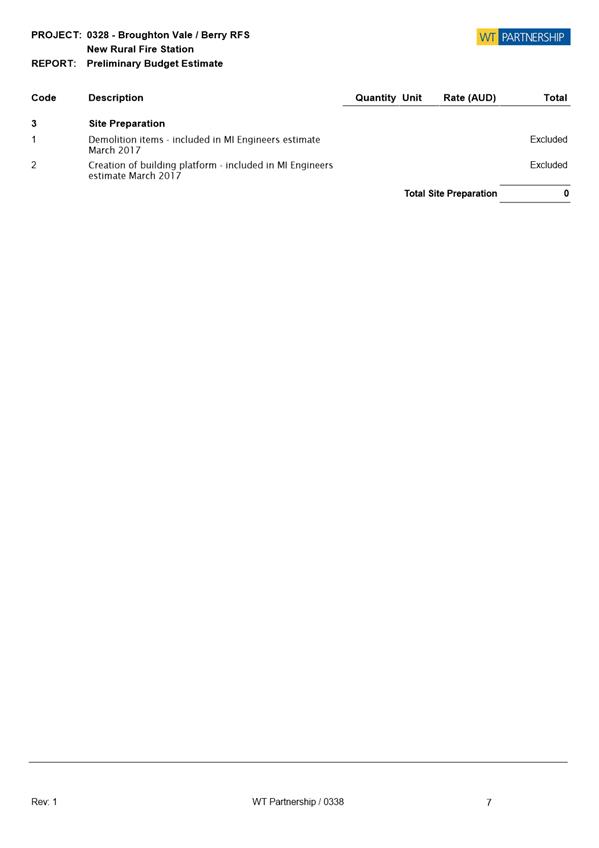

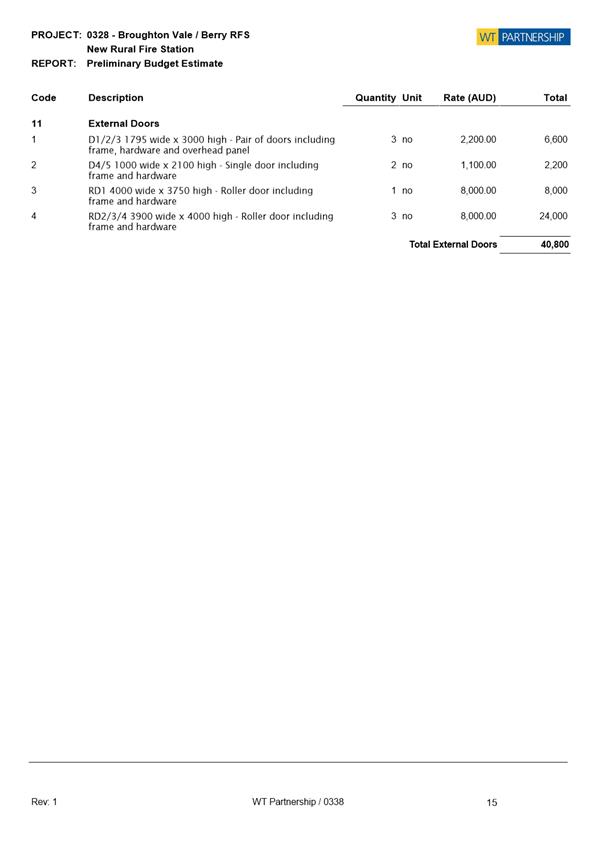

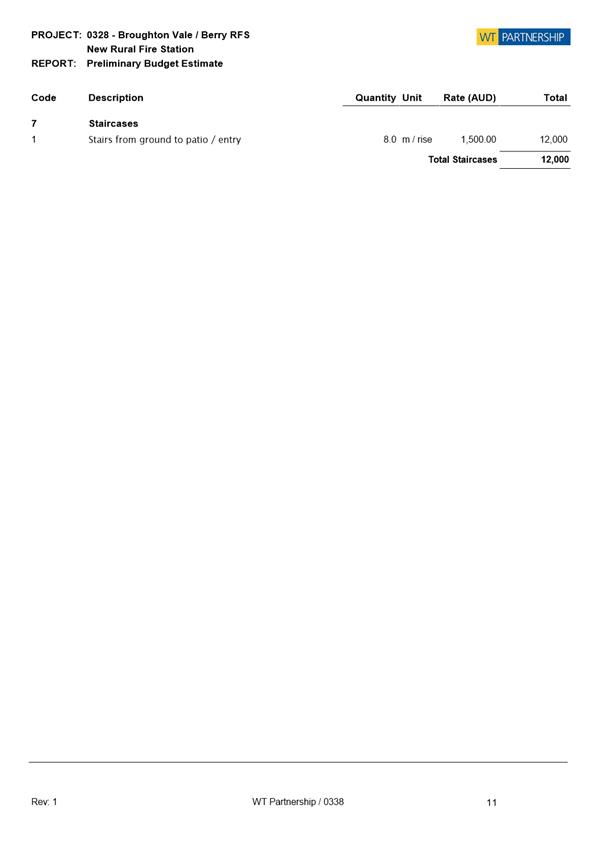

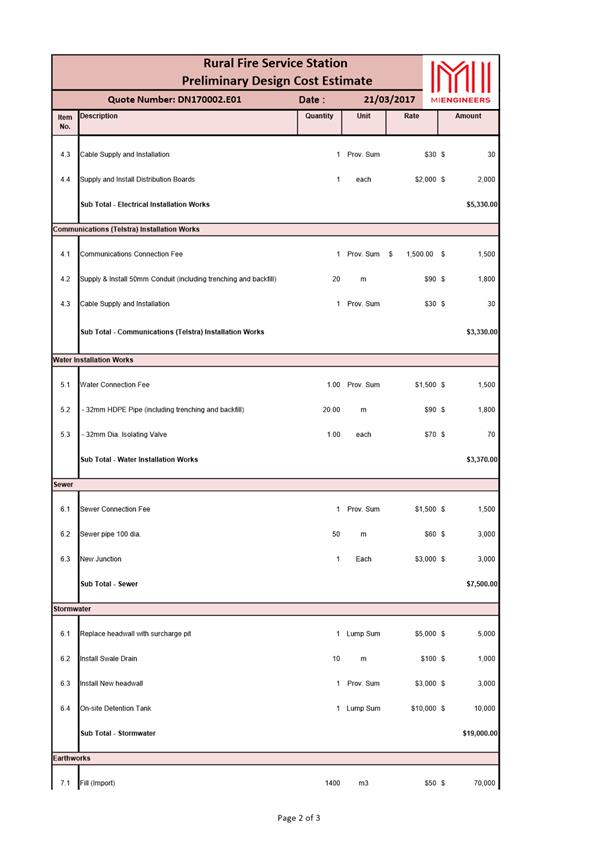

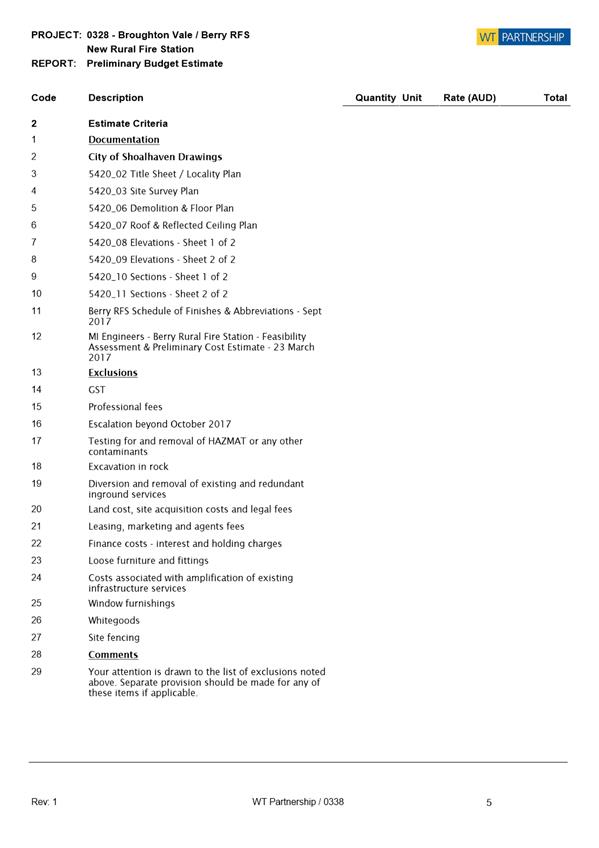

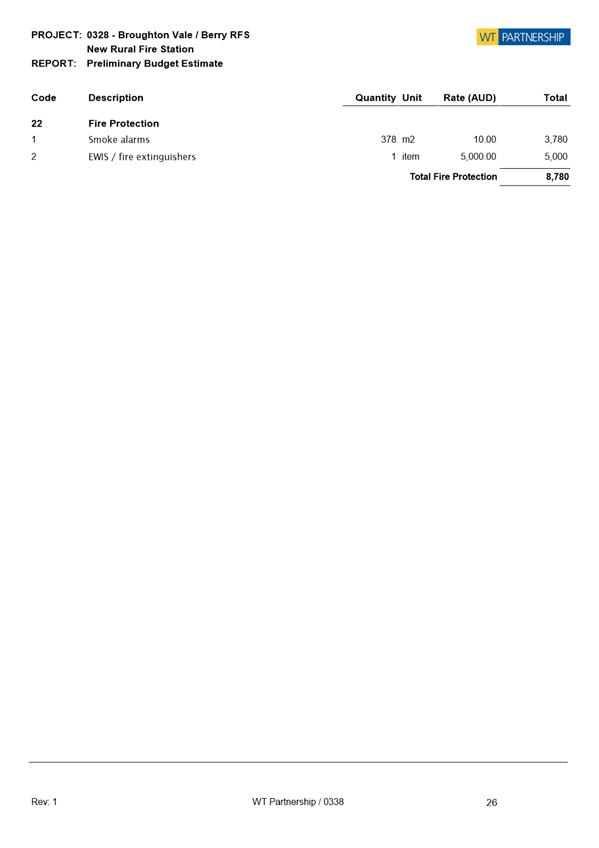

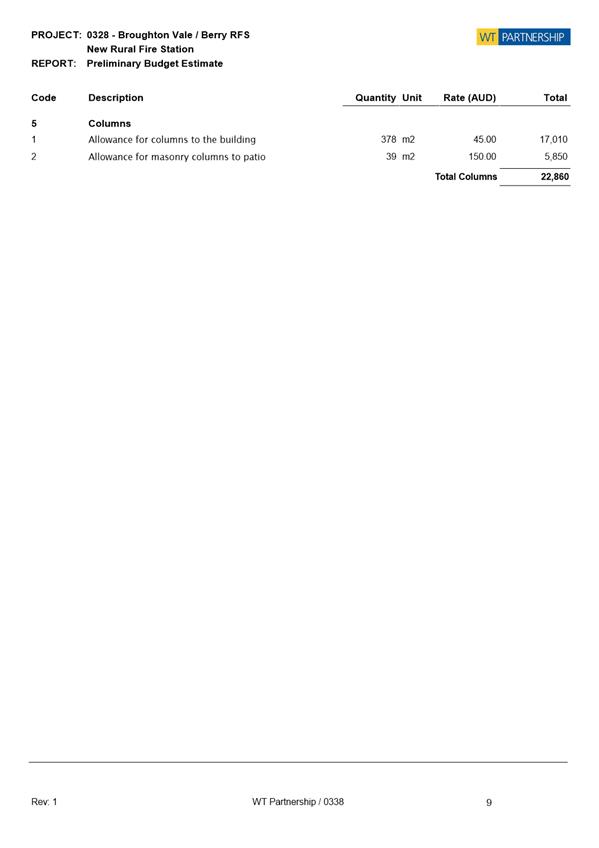

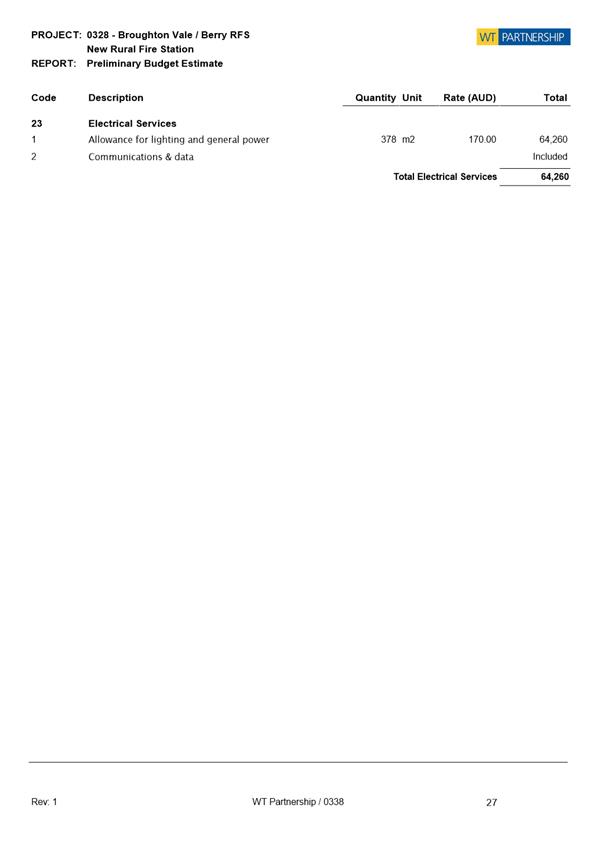

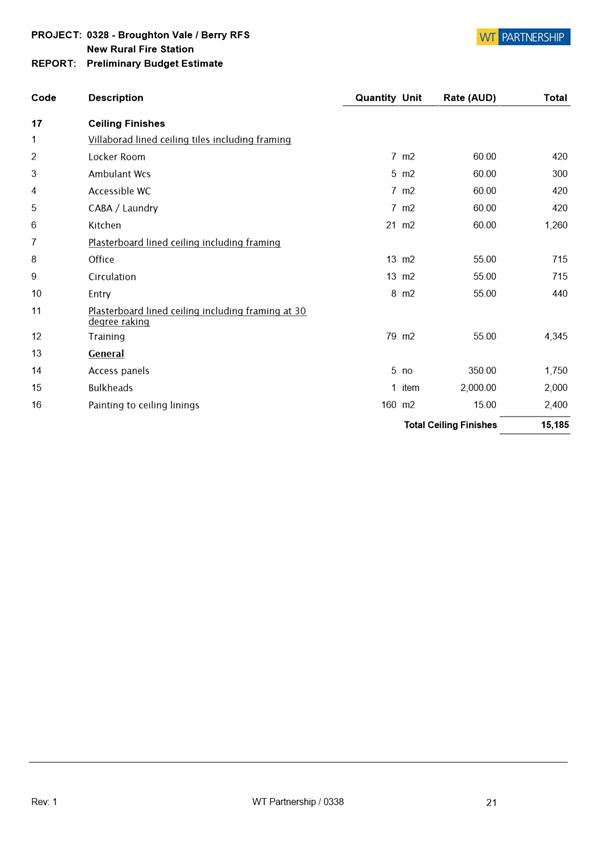

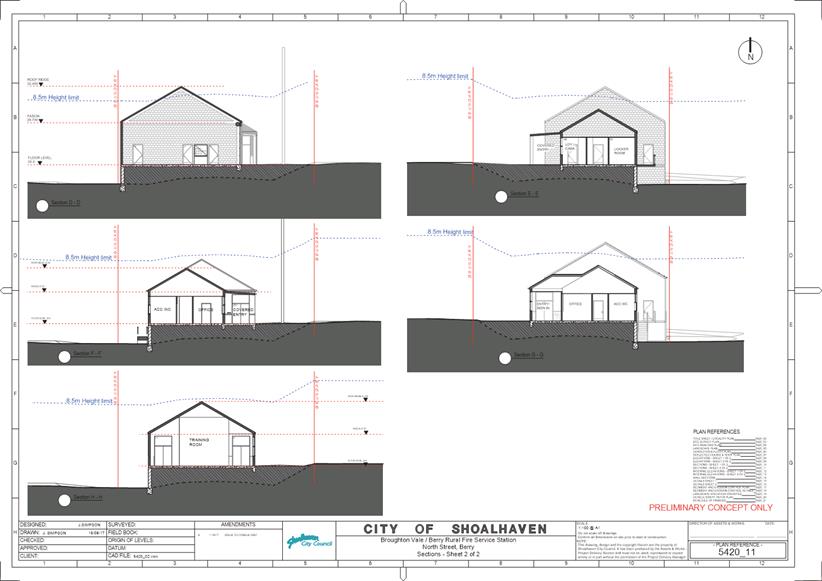

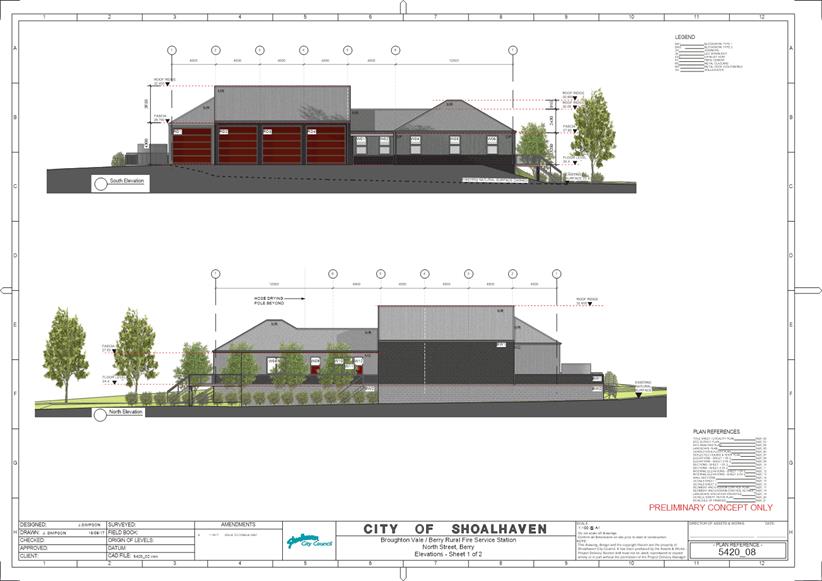

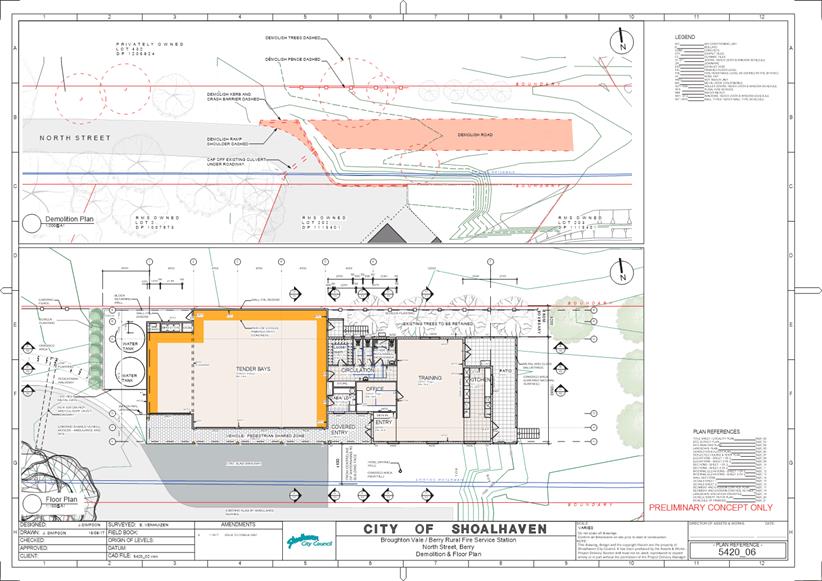

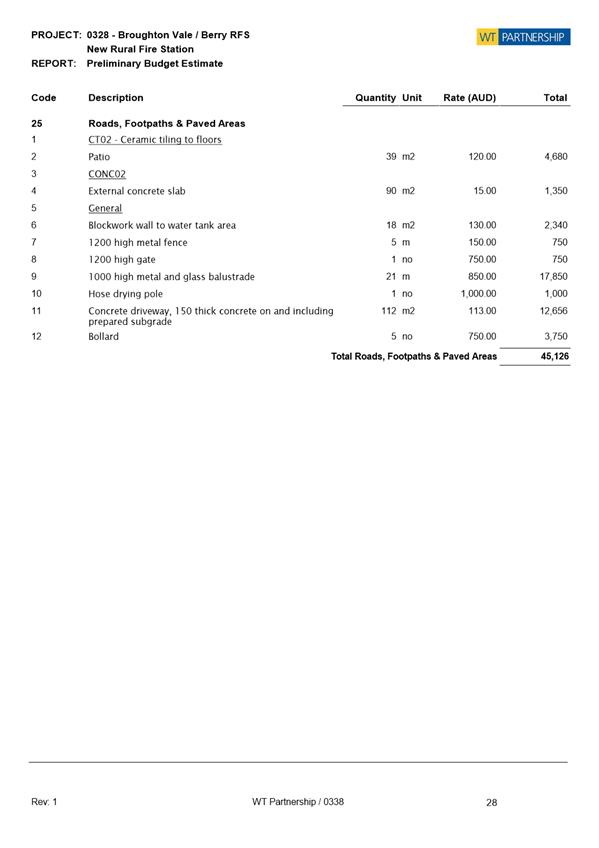

The Fire Control Officer advised that the RFS was looking at a cost of approximately $1.3-1.4 Million to build the Broughton Vale / Berry fire station in the proposed location.  The works for the adjacent ambulance station were imminent.  The site was a great location due to its proximity to the highway and township of Berry. The cost estimated provided for $400,000 in civil works.

The Fire Control Officer asked Council to carry out a cost / benefit investigation of alternative sites in the area to see if there was a more cost effective option available.  Alternatively, and preferably it was queried if Council could fund the $400,000 in civil works.

Michael Strachan undertook to provide The Fire Control Officer with a cost estimate for carrying out the cost / benefit investigation of alternative sites for the Broughton Vale / Berry Rural Fire Station.

Recommendation (Item to be determined under delegated authority)

That

1.    The Committee requests Council revisits the level of proposed civil works proposed with a view to exploring alternate options or exemptions to current requirements.

2.    The Committee requests Council considers undertaking or contributing to the cost of the civil works required to have the site prepared for station construction.

3.    The Committee requests Council it reviews available land parcels in the Berry area that maybe suitable for a RFS station.

4.    In the meantime, the Committee requests Council continue to work with HINFRA, RMS and Dept Lands to formalise the land use agreements and secure the identified land parcel.

5.    The Committee request Council provide the RFS a fully detailed costing of ALL required civil works for the proposed site, including power, water, sewerage, drainage etc.

6.    The Committee requests Council make contact with Health Infrastructure (HINFRA) in relation to their current build program on the site and a view to effectively reducing the level of cost of civil works on the RFS portion of the site.

7.    The Committee requests Council identify their capability to undertake all the above recommendations in a timely manner, and if not possible, then consideration be given to appointing the Department of Public Works as the principle contractor for the project.

8.    The Committee endorses the District Manager to seek the transfer of $37,000 of funds allocated to this project to the Kioloa station project (item 5) to allow for its completion.

RESOLVED (Mark Williams / Andrew Fielding)

That

1.    The Committee requests Council revisits the level of proposed civil works proposed with a view to exploring alternate options or exemptions to current requirements.

2.    The Committee requests Council considers undertaking or contributing to the cost of the civil works required to have the site prepared for station construction.

3.    The Committee requests Council it reviews available land parcels in the Berry area that maybe suitable for a RFS station.

4.    In the meantime, the Committee requests Council continue to work with HINFRA, RMS and Dept Lands to formalise the land use agreements and secure the identified land parcel.

5.    The Committee request Council provide the RFS a fully detailed costing of ALL required civil works for the proposed site, including power, water, sewerage, drainage etc.

6.    The Committee requests Council make contact with Health Infrastructure (HINFRA) in relation to their current build program on the site and a view to effectively reducing the level of cost of civil works on the RFS portion of the site.

7.    The Committee requests Council identify their capability to undertake all the above recommendations in a timely manner, and if not possible, then consideration be given to appointing the Department of Public Works as the principle contractor for the project.

8.    The Committee endorses the District Manager to seek the transfer of $37,000 of funds allocated to this project to the Kioloa station project (item 5) to allow for its completion.

9.    Michael Strachan to provide a cost estimate to the FCO for carrying out the cost/benefit investigation to alternative sites for the Broughton Vale/Berry station.

CARRIED

RF17.35     IEMC "Pad Mount" Transformer

HPERM Ref: D17/360131

Commentary provided under RF17.28

Recommendation (Item to be determined under delegated authority)

That Council expedites the construction, connection and finalisation of this project as a matter of urgency so as full reimbursement can be requested.

RESOLVED (Mark Williams / Paul Gleeson)

That Council expedites the construction, connection and finalisation of this project as a matter of urgency so as full reimbursement can be requested.

CARRIED

General Business

RF17.36     Code of Conduct

HPERM Ref: D17/360291

No matters

RF17.37     Work Health & Safety (WHS)

HPERM Ref: D17/360307

No matters

RF17.39     Additional Item - Representation - Drawing Room Rocks - Walking Track

At a recent meeting attended by the Fire Control Officer, the land owner adjoining the track to Drawing Room Rocks had raised concerns in relation to: the number of visitors, the inadequacy of the parking and the potential for impeded vehicular access in the event of an emergency.  The land owner may be willing to give Council a parcel of land to ease the parking congestion.

RF17.40     Additional Item - Emergency Operations Centre Meeting Room

The new Emergency Operations Centre meeting room (except for the fit out) had been paid for by the Rural Fighting Fund.  It appeared that Council was restricting access to this room unless this was cleared by the LEMO.

It was queried why the new room was not being used in the same manner as its predecessor as there had been no change in philosophy behind the room use.  The room needed to be available to all emergency services.

RESOLVED (Mark Williams / Paul Gooey)

That Council restore the former booking system/regime for the EOC meeting room.

CARRIED

Addendum Reports

RF17.38     RFS Project Update

HPERM Ref: D17/396671

Recommendation (Item to be determined under delegated authority)

That the report concerning the status of RFS projects be received for information.

RESOLVED (Mark Williams / Paul Gooey)

That the report concerning the status of RFS projects be received for information.

CARRIED

There being no further business, the meeting concluded, the time being 7.00pm.

Clr Mitchell Pakes

CHAIRPERSON

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 11

RF18.1       RFS Infrastructure Preface

HPERM Ref:       D18/35250

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That the Committee receives the report for information

Details

The below table shows the current Infrastructure component of the Strategic Capital Expenditure Program (SCEP).  This table is detailed in order of funding allocated and priorities as to these and future.  (These priorities may change from time to time as required.)

It should be noted that changes to the RFS policy, now sees projects being funded in a maximum of two stages, being:

1.   the allocation of ‘seed’ or preparatory funding for costs encountered during the planning phase (reports, plans, consultants etc)

2.   the allocation of full cost to complete the project based on quantity cost estimates.

#

PROJECT NAME

ALLOCATED

COST EST

SHORTFALL

1

Kangaroo Valley ablutions/extension

$   600,000

   580,000

nil

2

Shoalhaven Heads extension

$   671,028

   675,272

nil

3

Kioloa Station extension

$   370,000

   371,876

nil

4

IEMC Pad Mount Transformer

$   165,000 (RFS)

$   135,000 (SCC)

   300,000

nil

5

Milton Station extension

$     35,000

     35,000

nil

6

Tabourie Station extension

$     27,000

   490,544

   463,544

7

Broughton Vale Station (new)

$     50,000

1,341,000

1,291,000

8

Currarong Station extension

$

   U/K

  TBA

9

Conjola station extension

$

   U/K

   TBA

10

Wandandian station extension

$

   U/K

   TBA

11

Basin View station extension

$

   U/K

   TBA

12

Huskisson station extension

$

   U/K

   TBA

13

Beaumont station extension

$

   U/K

   TBA

14

Manyana Satellite garage & Main Stn alterations

$

   U/K

   TBA

15

Training, Logistics, SMSS Facility (TLSF) (new)

$

9,450,000

9,450,000

TOTALS

$2,053,028

$13,243,692

$11,204,544

All of these are in various forms of completion, from seed/investigation/planning, through to construction.  As shown above, some have funding allocated and are listed as committed projects.

Note: Other projects listed will be bid for in following years estimates or at other times as required.  It should be noted that in relation to project #15 other external RFS sections (SMSS & State Logistics) will be housed in the proposed facility and therefore these sections will be expected to contribute to the cost.

Each of these items is dealt with separately.

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 13

RF18.2       Other RFS Infrastructure Projects

HPERM Ref:       D18/35321

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That the Committee receives the report for information

Details

1.   Milton/Catering Station extensions

Current budget allocated                          $  35,000.00

Cost estimate of project:                           $  35,000.00

Variance:                                                   $  nil

The expenditure of these funds is all but complete with some painting still outstanding.

Once completed reimbursement claim will be submitted to RFS Region ASAP.

2.   Conjola Station extensions

Current budget allocated:                         $

Cost estimate of project:                           $ U/K

Variance:                                                   $TBA

No funding is currently allocated to this project.

Consideration will be given to seeking seed funding for this project to DA stage in a future budget

This project remains within the Shoalhaven Strategic Capital Expenditure Program (SCEP) and as such will remain on the DM SPC report.

3.   Wandandian station extensions

Current budget allocated:                         $

Cost estimate for project:                          $U/K

Variance:                                                   $TBA

No funding is currently allocated to this project.

Consideration will be given to seeking seed funding for this project to DA stage in a future budget

This project remains within the Shoalhaven Strategic Capital Expenditure Program (SCEP) and as such will remain on the DM SPC report.

4.   Basin View Station extensions

Current budget allocated:                         $

Cost estimate for project:                         $U/K

Variance:                                                   $TBA

No funding is currently allocated to this project.

Consideration will be given to seeking seed funding for this project to DA stage in a future budget

This project remains within the Shoalhaven Strategic Capital Expenditure Program (SCEP) and as such will remain on the DM SPC report.

5.   Huskisson Station extensions

Current budget allocated:                         $

Cost estimate of project:                           $U/K

Variance:                                                   $TBA

No funding is currently allocated to this project.

Consideration will be given to seeking seed funding for this project to DA stage in a future budget

This project remains within the Shoalhaven Strategic Capital Expenditure Program (SCEP) and as such will remain on the DM SPC report.

6.   Beaumont Station extensions

Current budget allocated:                         $ 0.00

Cost estimate of project:                           $U/K

Variance:                                                   $TBA

No funding is currently allocated to this project.

Consideration will be given to seeking seed funding for this project to DA stage in a future budget

This project remains within the Shoalhaven Strategic Capital Expenditure Program (SCEP) and as such will remain on the DM SPC report.

7.   Manyana Satellite garage & Main Stn Alterations

Planning works for the two Brigade facilities will be undertaken as soon as funding can be secured through the RFFF, in line with District priorities.

8.   Training/Logistics/SMSS Facility (TLSF)

Current budget allocated                          $

Cost estimate of project:                           $9,500,000.00

Variance:                                                   $9,500,000.00

Nothing new to report.

RFS Infrastructure Management (Sydney) has not progressed the issue.

This project is now on hiatus whilst other Infrastructure works are occurring.  The District (when able), will formalise the project proposal documentation which including all plans and costings undertaken to date and officially resubmit through Region and Head Office.

9.   2018/19 RFFF Estimates

The 2018/19 RFFF Estimates are now being compiled.

This is the second year of the amended estimate and allocation process.

This will see the amount of required contribution by Council fixed to a percentage of the total Rural Fire Fighting Fund (RFFF). Council’s mandatory contribution percentage has been advised as 2.664%.

It is hoped that the District will be successful in obtaining further infrastructure funding this coming year.  However, ongoing delays in expending current and previous allocations may again have a detrimental effect on this.

The $300,000 bid for the new “Pod” Logistics vehicle will again be included into the bid.

10. Staff Movements

Since last report, Mr Joshua Gregory has taken up ongoing employment to the OPO1 position vacated by James Morris.

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 16

RF18.3       Kangaroo Valley Station Additions

HPERM Ref:       D18/35438

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That Council, as a matter of urgency undertakes a full review of their management of these projects with a view to having any changes required implemented so that no further delays are experienced and the project is completed with haste.

Details

Current budget allocated:                               $400,000.00

Cost estimate of project:                                 $637,676.00

Variance:                                                         $237,676.00

Since last report, the DA has now been approved.  Funding for the shortfall/variance ($238K) has been identified and put in place.

Despite assurances that the Tenders for this (and projects 2&3) would be advertised prior to Christmas 2017, this did not occur.   Council’s Project Manager advised RFS against advertising tenders so close to Christmas due to danger of not reaching all companies because of the Construction Industry Holiday period close down.

Assurances were provided that the tenders would be advertised in the 2nd half of January.

During this period, the DM was requested to provide information confirming adequate funds for each project subject to tender.  This was provided to Council on at least two occasions prior to Christmas.

Alarmingly, in the last week of January the tenders still had not been advertised.  Since then, the DM has met with Mr Paul Keech and subsequently Mr Tom Dimec in another effort to rectify this matter with urgency.  RFS has received another assurance that the tenders will be let on Fri 2.2 or Mon 5.2.18

As a result of this inaction, RFS District has been reprimanded by Head Office in regard to the tenders not being advertised in January as was assured.

It cannot be stressed highly enough how serious the situation is with this funding.

Any further delays in management of this project is likely to see allocated funding withdrawn.  Council has been warned of this possibility on numerous occasions both via this committee and during direct meetings with senior staff, the General Manager and Councillors.  Should this occur, it will not only jeopardise this project, but also potentially impact any future funding bid by Shoalhaven for Infrastructure projects.

It is in Council’s best interest to secure as much funding allocations as possible.  To not capitalise on this would not see a reduction of Council’s contribution to the RFFF, and will also result in no provision of upgraded facilities/infrastructure for the 1,800 volunteer members of the District RFS Brigades and the communities in which they serve.

*****

Director Assets and Works Recommendation

That the Committee note that;

1.   Tenders for the construction of the Kangaroo Valley RFS Station Extension have been called and the closing date for submissions is 6 March 2018.

2.   The NSWRFS will be involved in the Contractor Selection process and invited to Project Manage the works (via the NSW Department of Public Works) so the project can be completed as per the NSWRFS requirements

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 18

RF18.4       Shoalhaven Heads Extensions

HPERM Ref:       D18/35452

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That Council, as a matter of urgency undertakes a full review of its management of these projects with a view to having any changes required implemented so that no further delays are experienced and the project is completed with haste.

Details

Current budget allocated:                               $671,028.00

Cost estimate of project:                                 $675,272.00

Variance:                                                         $           0.00

Since last report, the DA has now been approved.  Funding transfers for the previous variance ($275K) has now occurred.

Despite assurances that the Tenders for this (and projects 2&3) would be advertised prior to Christmas 2017, this did not occur.   Council’s Project Manager advised RFS against advertising tenders so close to Christmas due to danger of not reaching all companies because of the Construction Industry Holiday period close down.

Assurances were provided that the tenders would be advertised in the 2nd half of January.

During this period, the DM was requested to provide information confirming adequate funds for each project subject to tender.  This was provided to Council on at least two occasions prior to Christmas.

Alarmingly, in the last week of January the tenders still had not been advertised.  Since then, the DM has met with Mr Paul Keech and subsequently Mr Tom Dimec in another effort to rectify this matter with urgency.  RFS has received another assurance that the tenders will be let on Fri 2.2 or Mon 5.2.18

As a result of this inaction, RFS District has been reprimanded by Head Office in regard to the tenders not being advertised in January as was assured.

It cannot be stressed highly enough how serious the situation is with this funding.

Any further delays in management of this project is likely to see allocated funding withdrawn.  Council has been warned of this possibility on numerous occasions both via this committee and with Direct meetings with senior staff, the General Manager and Councillors.  Should this occur, it will not only jeopardise this project, but also potentially impact any future funding bid by Shoalhaven for Infrastructure projects.

It is in Council’s best interest to secure as much funding allocations as possible.  To not capitalise on this would not see a reduction of Council’s contribution to the RFFF, and will also result in no provision of upgraded facilities/infrastructure for the 1,800 volunteer members of the District RFS Brigades and the communities in which they serve.

*****

Director Assets and Works Recommendation

That the committee note that;

1.   Tenders for the construction of the Shoalhaven Heads RFS Station Extension have been called and the closing date for submissions is 6 March 2018.

2.   The NSWRFS will be involved in the Contractor Selection process and invited to Project Manage the works (via the NSW Department of Public Works) so the project can be completed as per the NSWRFS requirements

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 20

RF18.5       Kioloa Station Extensions

HPERM Ref:       D18/35469

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That Council, as a matter of urgency undertakes a full review of its management of these projects with a view to having any changes required implemented so that no further delays are experienced and the project is completed with haste

Details

Current budget allocated:                               $370,000.00

Cost estimate for project:                               $371,876.00

Variance:                                                         $nil

Since last report, the DA has now been approved.  Funding transfers for the previous variance ($187K) has now occurred.

Despite assurances that the Tenders for this (and projects 2&3) would be advertised prior to Christmas 2017, this did not occur.   Council’s Project Manager advised RFS against advertising tenders so close to Christmas due to danger of not reaching all companies because of the Construction Industry Holiday period close down.

Assurances were provided that the tenders would be advertised in the 2nd half of January.

During this period, the DM was requested to provide information confirming adequate funds for each project subject to tender.  This was provided to Council on at least two occasions prior to Christmas.

Alarmingly, in the last week of January the tenders still had not been advertised.  Since then, the DM has met with Mr Paul Keech and subsequently Mr Tom Dimec in another effort to rectify this matter with urgency.  RFS has received another assurance that the tenders will be let on Fri 2.2 or Mon 5.2.18

As a result of this inaction, RFS District has been reprimanded by Head Office in regard to the tenders not being advertised in January as was assured.

It cannot be stressed highly enough how serious the situation is with this funding.  Any further delays in management of this project is likely to see allocated funding withdrawn.  Council has been warned of this possibility on numerous occasions both via this committee and with Direct meetings with senior staff, the General Manager and Councillors.  Should this occur, it will not only jeopardise this project, but also potentially impact any future funding bid by Shoalhaven for Infrastructure projects.

It is in Council’s best interest to secure as much funding allocations as possible.  To not capitalise on this would not see a reduction of Council’s contribution to the RFFF, and will also result in no provision of upgraded facilities/infrastructure for the 1,800 volunteer members of the District RFS Brigades and the communities in which they serve.

Director Assets and Works Recommendation

That the committee note that;

1.   Tenders for the construction of the Kioloa RFS Station Extension have been called and the closing date for submissions is 6 March 2018.

2.   The NSWRFS will be involved in the Contractor Selection process and invited to Project Manage the works (via the NSW Department of Public Works) so the project can be completed as per the NSWRFS requirements

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 22

RF18.6       IEMC "Pad Mount" Transformer

HPERM Ref:       D18/35563

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That Council expedite the supply of required documents and information so that a reimbursement claim can be compiled and processed.

Details

Current budget allocated:                               $165,000.00 (RFFF) & $135,000 (SCC)

Cost estimate of project:                                 $300,000.00

Variance:                                                         $0.00

Site works on this project are continuing.  The project is behind schedule due to delays involving contractor machinery and Integral Electricity regarding “cut over”.

Council Project Management has advised that with no further delays expected, the project should be complete by end Feb ‘18

Repeated requests have been made for Council to supply documents and information required so that reimbursement of the allocated funds can be made ASAP.

*****

Director Asset and Works Recommendation

That the Committee note that invoices for this project will be forwarded once Council’s Finance Section have completed the Council Budget December Quarterly Review responsibilities.

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 23

RF18.7       Tabourie Station Extensions

HPERM Ref:       D18/35590

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That

1.    Council continues to work with Department of Lands to resolve land use agreement

2.    The DA for the project be submitted to Council for determination

Details

Current budget allocated                                $  27,000.00

Cost estimate of project:                                 $498,593.00

Variance:                                                         $471,593.00

No further information on the status of this project has been received from Council since last report.

Once the DA is approved (subsequent to land approval issue being resolved), the District Manager will be in a position to request funding for the shortfall in project cost.

*****

Director Assets and Works Recommendation

That the committee note;

1.   that the Development Application for the Tabourie RFS Station Extensions has been stalled due the inability to obtain “Owners Consent” from Crown Lands. The existing RFS station is inconsistent with the reserve purpose (public recreation) and thus under the Native Title Act the existing use is invalid and has not extinguished native title. The Extinguishment of Native Title is not a certainty and this process could take 6 to 12 months to work through.

2.   The cost to make a Non-Claimant Native Title Application and pay compensation to the Native Title Landholders if any, is to be met by Council initially and there is currently no budget for this work.

3.   This cost would not be incurred if the station remains as is, therefore Council would seek assurances that these costs would be include in the project cost and thus reimbursed by the RFS, before any further work is undertaken in relation to extinguishing Native Title. An estimate of the cost of this process is being prepared for a future committee meeting.

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 24

RF18.8       Broughton Vale / Berry Rural Fire Station

HPERM Ref:       D18/35613

Submitted by:    The Fire Control Officer, The Superintendent Mark Williams

Attachments:     1. Preliminary Concept Plans

2. MI Engineers cost estimate

3. WT Partnership cost estimate

4. Concept Cost Estimate

Recommendation (Item to be determined under delegated authority)

That Council

1.    reviews the level of proposed civil works proposed with a view to exploring alternate options or exemptions to current requirements.

2.    reports to the District Manager and Committee the outcome of previous request for them to consider undertaking the civil works at their cost or contributing towards same.

3.    provides the RFS a fully detailed costing of ALL required civil works for the proposed site, including power, water, sewerage, drainage etc.

4.    continues to progress this project to DA approval/tender advertising stage, to allow RFS to seek funding allocation.

Details

Current budget allocated                                  $50,000.00

Cost estimate of project               (approx.) $1,341,000.00

Variance                                                       $1,291,421.00

Last meeting saw a resolution seeking Council to review this project with view to its capacity to commit to funding the $429,000 of civil works required for this project.   To date, no advice on this matter has been received.

Council did advise that the alternative sites listed in last report were unlikely to be any cheaper to acquire or construct on for various reasons including:

·    Cost of undertaking separate investigations

·    Potential cost of acquisition

·    Distance between proposed sites and services required (power, water, sewer etc.)

*****

Director Assets and Works Recommendation

That the committee;

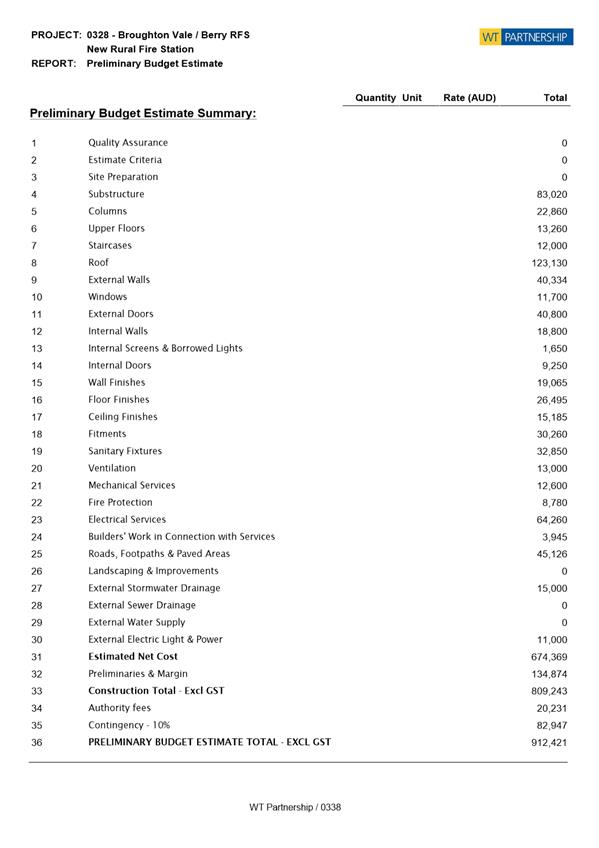

1.    endorse the set of drawings Plan Reference 5420 as the preferred concept design for the new Broughton Vale / Berry Rural Fire Services Station noting the estimated construction costs, based on the concept design, is $1,350,000 (exc GST).

2.    Note that Council has progressed the Road Closure to create the Lot upon which this station will be built and an application to register the Deposited Plan has been made to the Land Titles Office. The Gazettal process will follow the Registration process.

3.    note that Council does not subsidise the State Budget by making additional contributions to the provision of NSWRFS facilities, and a deviation from this practice would require a resolution of the Council.

4.    supports the NSWRFS Shoalhaven District Manager applying to the NSWRFS for funding for the new Broughton Vale / Berry Rural Fire Services Station project in the 2018/19 RFFF estimates to bring the project to fully costed, construction ready status.

5.    when funding is available the NSWRFS engages the NSW Department of Public Works as the Principle Contractor/Consultant for new Broughton Vale / Berry Rural Fire Services Station project, with Council assisting to have the project considered under the Infrastructure SEPP, if required.

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 26

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 36

PDF Creator

PDF Creator

PDF Creator

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 39

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 72

PDF Creator

 Rural Fire Service Strategic Planning Committee – Thursday 15 February 2018

Page 73

RF18.9       Currarong Station Additions

HPERM Ref:       D18/35631

Submitted by:    The Fire Control Officer, Superintendent Mark Williams

Recommendation (Item to be determined under delegated authority)

That Council

1.   Commits to project management through to fully costed DA approval within 12 months.

2.   If unable to commit to this, that Council approve the NSWRFS appointing the NSW Department of Public Works as the principle contractors for this project.

3.   The Committee endorses the District Manager to apply for seed funding for this project in the 2018/19 RFFF estimates to bring the project to fully costed DA status.

Details

Current budget allocated                                $0.00

Cost estimate of project:                                 $ U/K

Variance:                                                                     $ TBA

Concept Plans have been received from the architect. These have been endorsed by the Brigade. As per last meeting report and outcomes, previously allocated funds have been journaled to other projects.

Seed funding, sufficient to permit the project to be planned through to fully costed DA approval will be bid for in the 2018/19 estimates – providing Council can commit to staffing and achieving same within 12 months of allocation.

*****

Director Asset and Works Recommendation

That;

1.   the Committee supports the NSWRFS Shoalhaven District Manager applying to the NSWRFS for seed funding for the Currarong Station Additions project in the 2018/19 RFFF estimates to bring the project to fully costed, construction ready status

2.   when funding is available, the NSWRFS engages the NSW Department of Public Works as the Principle Contractor/Consultant for Currarong Station Additions project, with Council assisting to have the project considered under the Infrastructure SEPP, if required.
